2026 Cul-de-Sac Repair

Share 2026 Cul-de-Sac Repair on Facebook Share 2026 Cul-de-Sac Repair on X (formerly Twitter) Share 2026 Cul-de-Sac Repair on Linkedin Email 2026 Cul-de-Sac Repair link

As part of the Ada County Highway District’s (ACHD) Cul-de-Sac Maintenance Program, ACHD will reconstruct and repave several cul-de-sacs in Ada County, starting as early as May 2026.

One week prior to work starting, message boards will be placed at the entrance of your neighborhood. The project is expected to be completed by late August.*

Cul-de-Sacs Included in the Work

  • 39th Street, south of Catalpa Drive

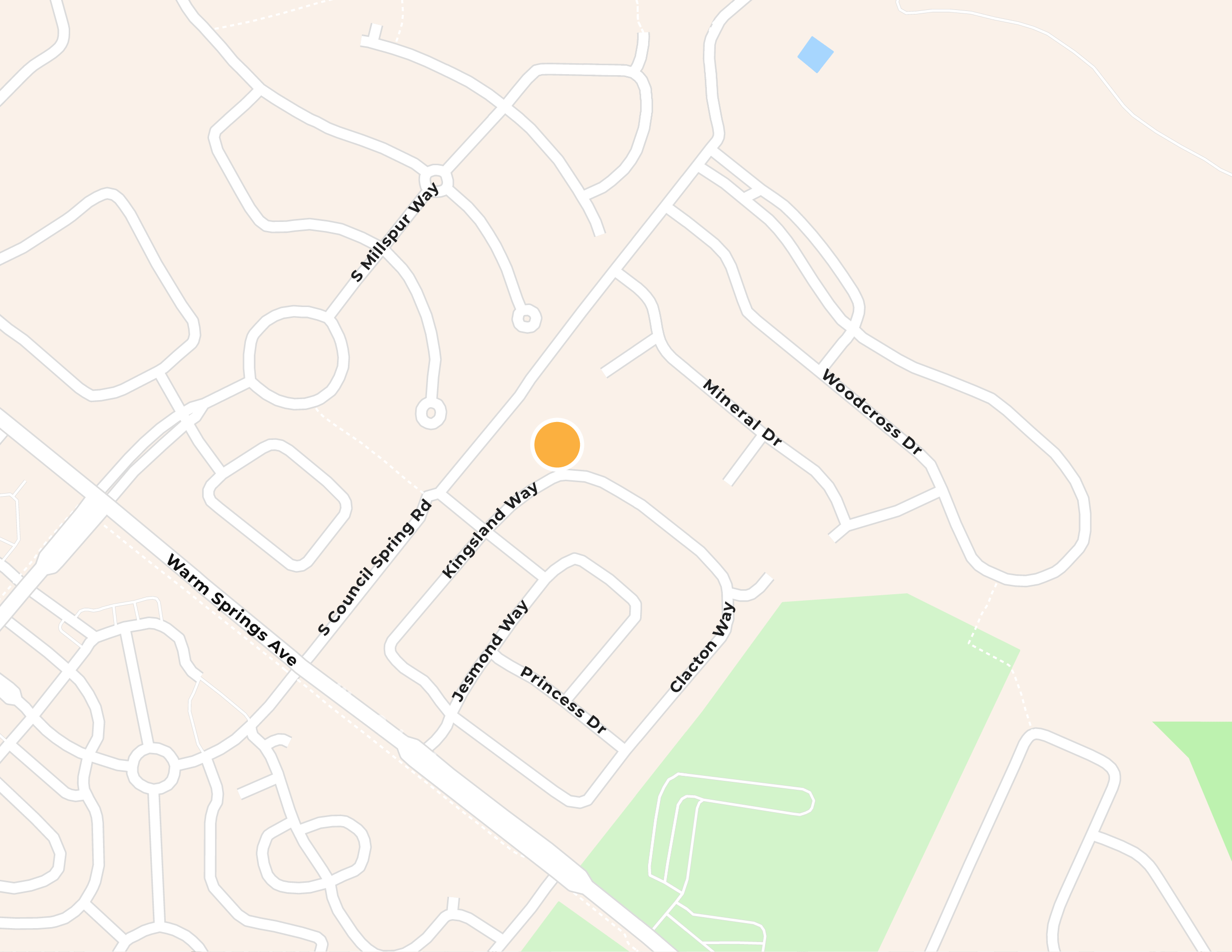

  • Kingsland Way, northeast of Warm Springs Avenue

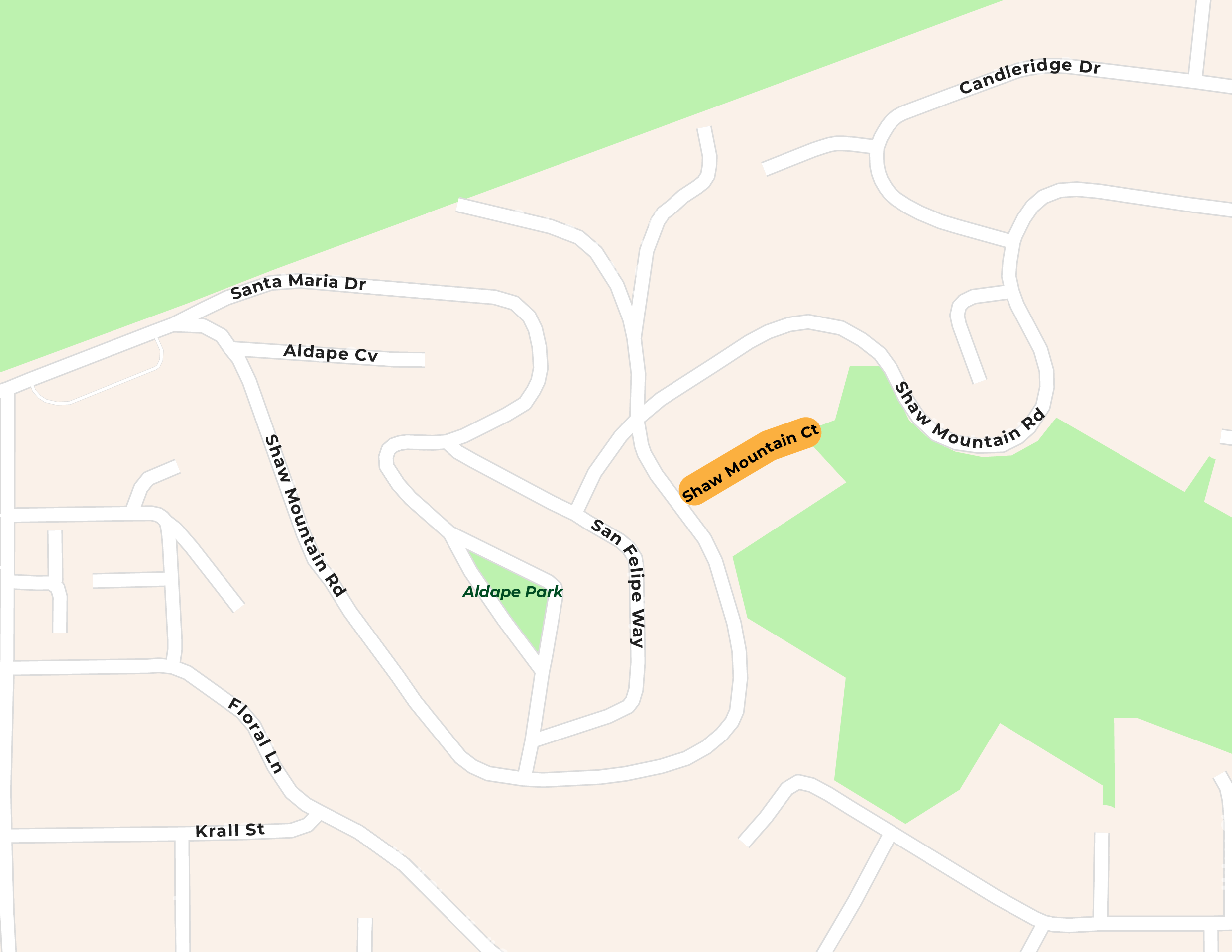

  • E Shaw Mountain Court, east of Santa Paula Place

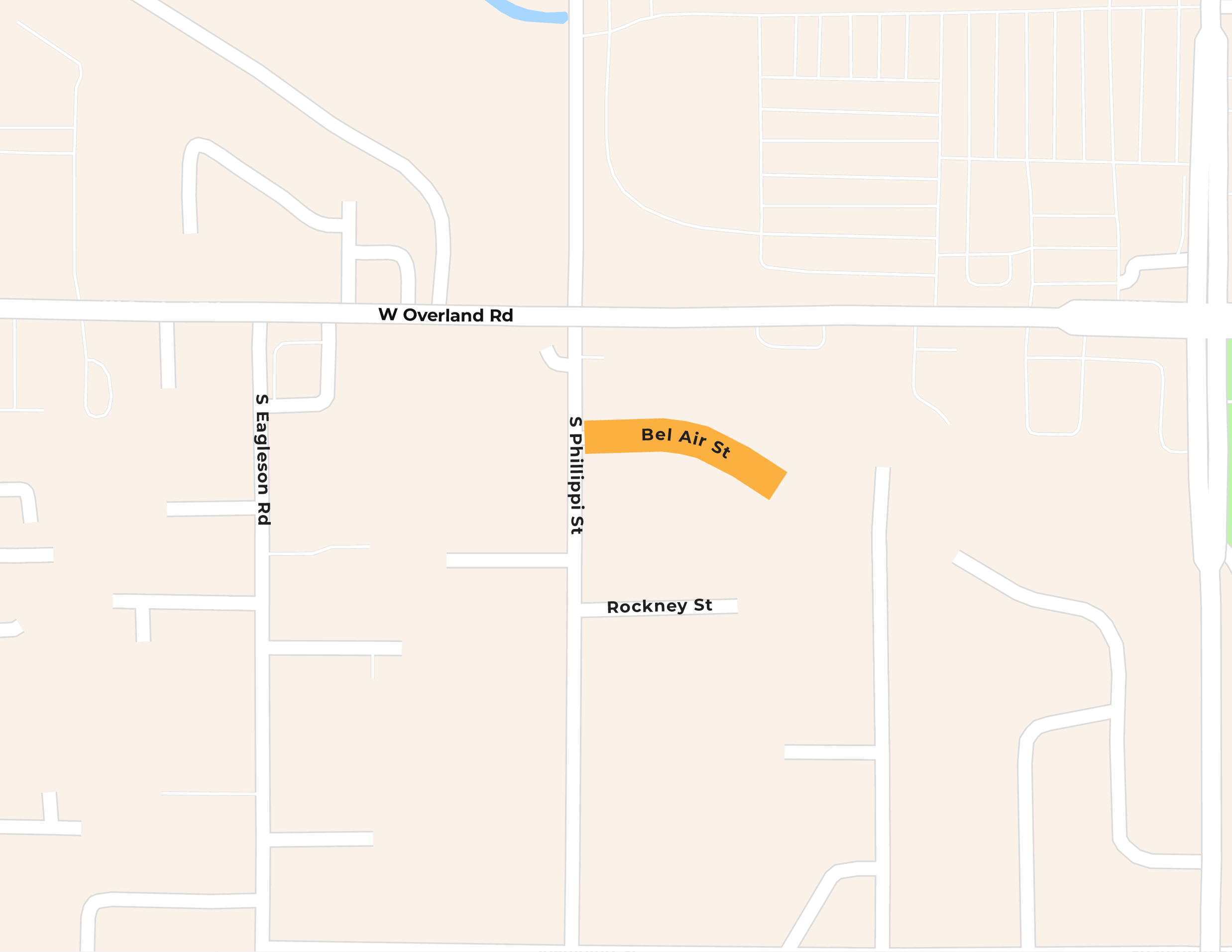

  • Bel Air St, east of Phillippi Street

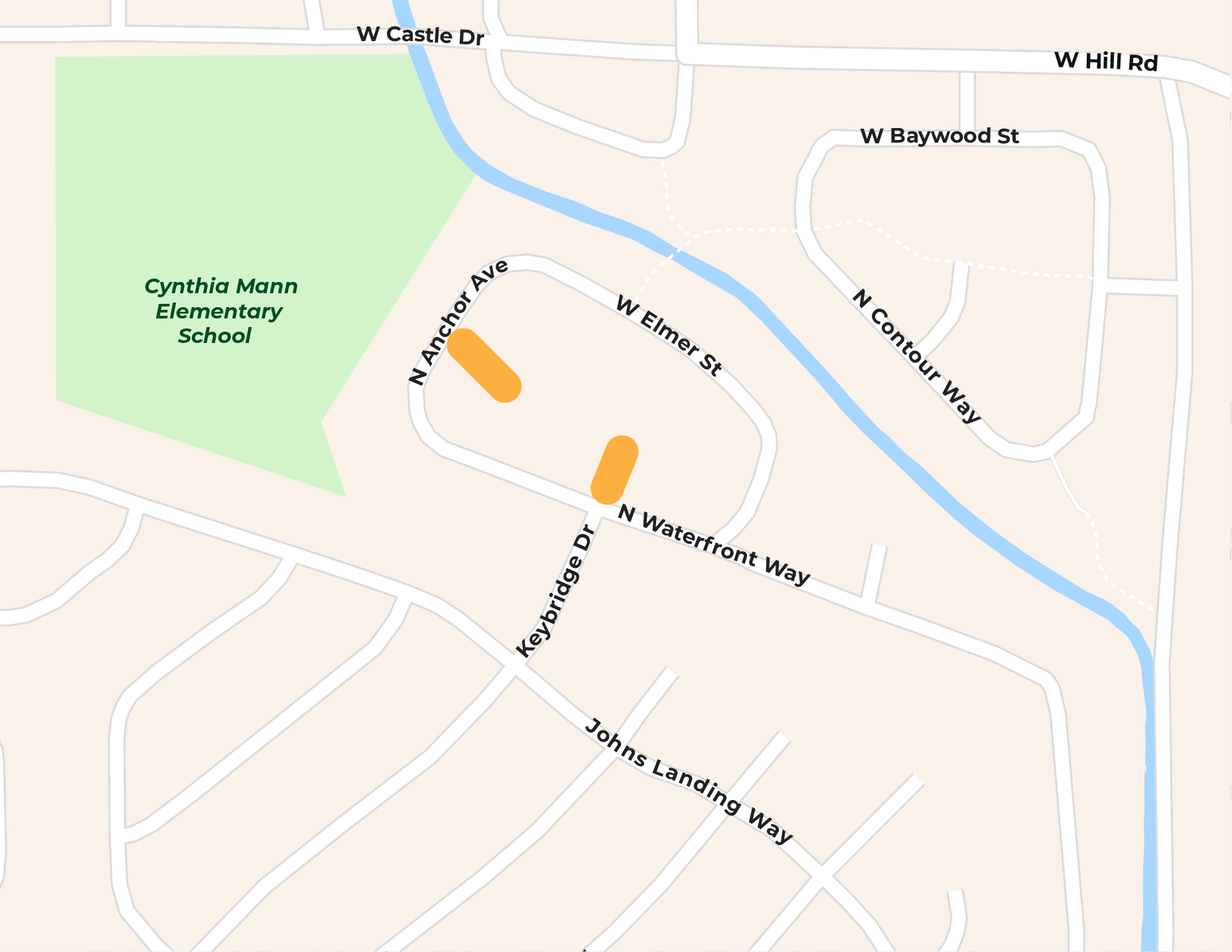

  • Keybridge Drive and N Achor Avenue

Construction Impacts

  • Access to driveways in the cul-de-sac may be restricted for a portion of the project duration and on-street parking in the project area will be limited during the span of the construction work
  • General construction noise, dust, equipment backup alarms, and ground vibration
  • Crews will work from 7 a.m. to 7 p.m. unless otherwise approved

*Construction schedules may change due to high demand for contractors, labor, and supplies.

As part of the Ada County Highway District’s (ACHD) Cul-de-Sac Maintenance Program, ACHD will reconstruct and repave several cul-de-sacs in Ada County, starting as early as May 2026.

One week prior to work starting, message boards will be placed at the entrance of your neighborhood. The project is expected to be completed by late August.*

Cul-de-Sacs Included in the Work

  • 39th Street, south of Catalpa Drive
  • Kingsland Way, northeast of Warm Springs Avenue
  • E Shaw Mountain Court, east of Santa Paula Place
  • Bel Air St, east of Phillippi Street
  • Keybridge Drive and N Achor Avenue

Construction Impacts

  • Access to driveways in the cul-de-sac may be restricted for a portion of the project duration and on-street parking in the project area will be limited during the span of the construction work
  • General construction noise, dust, equipment backup alarms, and ground vibration
  • Crews will work from 7 a.m. to 7 p.m. unless otherwise approved

*Construction schedules may change due to high demand for contractors, labor, and supplies.

  • July 1, 2026

    Share July 1, 2026 on Facebook Share July 1, 2026 on X (formerly Twitter) Share July 1, 2026 on Linkedin Email July 1, 2026 link
    • 39th Street (four locations) - Complete.
    • Kingsland Way - Ongoing.
    • Shaw Mountain Court - Ongoing.
    • W. Bel Air Street - Ongoing.
    • Keybridge Drive - Collars remaining.
    • N. Anchor Avenue - Collars and landscape repair remaining.
    • 39th Street (four locations) - Complete.
    • Kingsland Way - Ongoing.
    • Shaw Mountain Court - Ongoing.
    • W. Bel Air Street - Ongoing.
    • Keybridge Drive - Collars remaining.
    • N. Anchor Avenue - Collars and landscape repair remaining.
  • June 26, 2026

    Share June 26, 2026 on Facebook Share June 26, 2026 on X (formerly Twitter) Share June 26, 2026 on Linkedin Email June 26, 2026 link
    • 39th Street (four locations) - Cleanup and landscaping remaining.
    • Kingsland Way
    • Shaw Mountain Court
    • W. Bel Air Street - Started June 5th. Seepage bed ongoing.
    • Keybridge Drive - Ongoing.
    • N. Anchor Avenue - Started June 8th. Concrete ongoing.
    • 39th Street (four locations) - Cleanup and landscaping remaining.
    • Kingsland Way
    • Shaw Mountain Court
    • W. Bel Air Street - Started June 5th. Seepage bed ongoing.
    • Keybridge Drive - Ongoing.
    • N. Anchor Avenue - Started June 8th. Concrete ongoing.
  • June 18, 2026

    Share June 18, 2026 on Facebook Share June 18, 2026 on X (formerly Twitter) Share June 18, 2026 on Linkedin Email June 18, 2026 link
    • 39th Street (four locations) - Cleanup and landscaping remaining.
    • Kingsland Way
    • Shaw Mountain Court
    • W. Bel Air Street - Started June 5th. Seepage bed ongoing.
    • Keybridge Drive - Started June 8th.
    • N. Anchor Avenue - Started June 8th. Concrete ongoing.
    • 39th Street (four locations) - Cleanup and landscaping remaining.
    • Kingsland Way
    • Shaw Mountain Court
    • W. Bel Air Street - Started June 5th. Seepage bed ongoing.
    • Keybridge Drive - Started June 8th.
    • N. Anchor Avenue - Started June 8th. Concrete ongoing.
  • June 12, 2026

    Share June 12, 2026 on Facebook Share June 12, 2026 on X (formerly Twitter) Share June 12, 2026 on Linkedin Email June 12, 2026 link
    • 39th Street (four locations) - Paving June 11th
    • Kingsland Way
    • Shaw Mountain Court
    • W. Bel Air Street - Started June 5th. Seepage bed ongoing.
    • Keybridge Drive - Started June 8th. Demo ongoing.
    • N. Anchor Avenue - Started June 8th. Demo ongoing.
    • 39th Street (four locations) - Paving June 11th
    • Kingsland Way
    • Shaw Mountain Court
    • W. Bel Air Street - Started June 5th. Seepage bed ongoing.
    • Keybridge Drive - Started June 8th. Demo ongoing.
    • N. Anchor Avenue - Started June 8th. Demo ongoing.
Page last updated: 09 Jul 2026, 02:58 PM
