2025 Cul-de-Sac Repair

Share 2025 Cul-de-Sac Repair on Facebook Share 2025 Cul-de-Sac Repair on Twitter Share 2025 Cul-de-Sac Repair on Linkedin Email 2025 Cul-de-Sac Repair link

As part of the Ada County Highway District’s (ACHD) Cul-de-Sac Maintenance Program, ACHD will reconstruct and repave several cul-de-sacs in Ada County, starting as early as June 2025.

One week prior to work starting, message boards will be placed at the entrance of your neighborhood. The project is expected to be completed by late August.*

Cul-de-sacs included in the work:

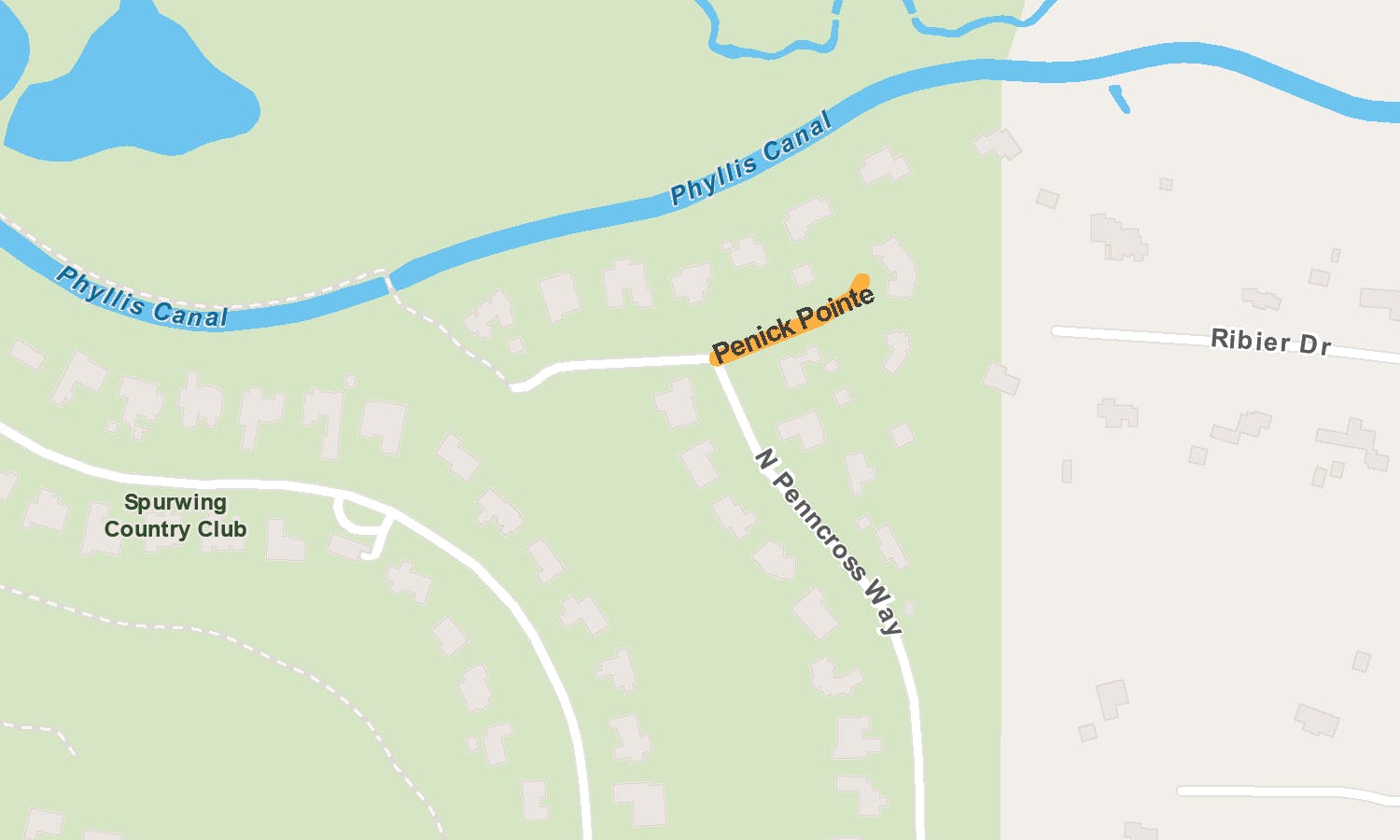

  • Penick Pointe Court, north of Penncross Way
  • Limelight Street, east of Gary Lane
  • Peachtree Street and Yorgason Way, east of Bluegrass Avenue
  • Ada Street, east of 10th Street

Construction impacts:

  • Access to driveways in the cul-de-sac may be restricted for a portion of the project duration and on-street parking in the project area will be limited during the span of the construction work
  • General construction noise, dust, equipment backup alarms, and ground vibration
  • Crews will work from 7 a.m. to 7 p.m. unless otherwise approved

*Construction schedules may change due to high demand for contractors, labor, and supplies.

As part of the Ada County Highway District’s (ACHD) Cul-de-Sac Maintenance Program, ACHD will reconstruct and repave several cul-de-sacs in Ada County, starting as early as June 2025.

One week prior to work starting, message boards will be placed at the entrance of your neighborhood. The project is expected to be completed by late August.*

Cul-de-sacs included in the work:

  • Penick Pointe Court, north of Penncross Way
  • Limelight Street, east of Gary Lane
  • Peachtree Street and Yorgason Way, east of Bluegrass Avenue
  • Ada Street, east of 10th Street

Construction impacts:

  • Access to driveways in the cul-de-sac may be restricted for a portion of the project duration and on-street parking in the project area will be limited during the span of the construction work
  • General construction noise, dust, equipment backup alarms, and ground vibration
  • Crews will work from 7 a.m. to 7 p.m. unless otherwise approved

*Construction schedules may change due to high demand for contractors, labor, and supplies.

  • July 18, 2025

    18 Jul 2025
    Share July 18, 2025 on Facebook Share July 18, 2025 on Twitter Share July 18, 2025 on Linkedin Email July 18, 2025 link
    • Penick Point - Complete
    • Limelight - Complete
    • Peachtree - Complete
    • Yorganson Way - Wrapping up this week
    • W Ada Street - Anticipated start July 21st
  • July 2, 2025

    02 Jul 2025
    Share July 2, 2025 on Facebook Share July 2, 2025 on Twitter Share July 2, 2025 on Linkedin Email July 2, 2025 link
    • Penick Pointe - Complete.
    • Limelight - Complete.
    • Peachtree - Anticipated start July 7th.
    • Yorganson Way - Anticipated start July 8th.
    • W Ada Street - Anticipated start July 14th.
  • June 26, 2025

    26 Jun 2025
    Share June 26, 2025 on Facebook Share June 26, 2025 on Twitter Share June 26, 2025 on Linkedin Email June 26, 2025 link
    • Penick Pointe - Complete.
    • Limelight - Complete.
    • Peachtree - Anticipated start July 7th.
    • Yorganson Way- Anticipated start July 8th.
    • W Ada Street - Anticipated start July 14th.
Page last updated: 18 Jul 2025, 11:14 AM
