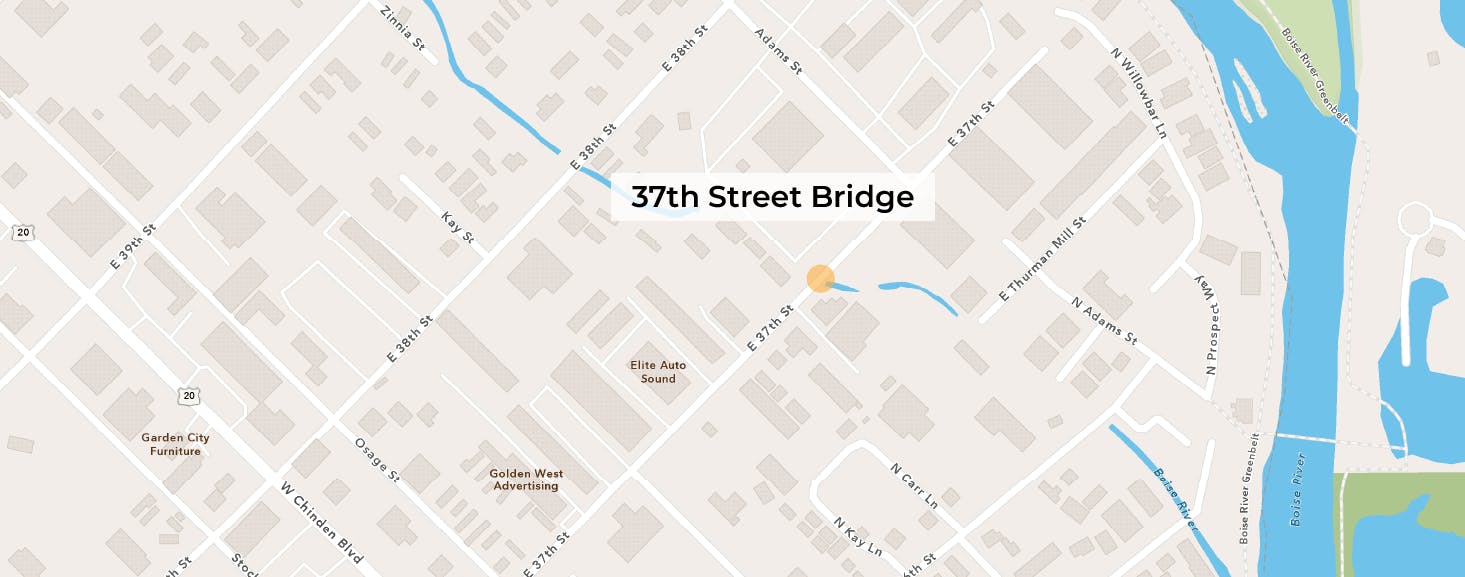

37th Street Bridge

Share 37th Street Bridge on Facebook Share 37th Street Bridge on Twitter Share 37th Street Bridge on Linkedin Email 37th Street Bridge link

Work substantially complete.

As part of the Ada County Highway District’s (ACHD) Bridge Maintenance Program, ACHD will replace the culvert on 37th Street, southwest of Adams Street, as early as the beginning of October 2023 .* Construction is expected to be complete spring of 2024.

This bridge improvement project will include removing and replacing the existing bridge over the Boise City Canal.

*Construction schedules may change due to high demand for contractors, labor, and supplies.

As part of the Ada County Highway District’s (ACHD) Bridge Maintenance Program, ACHD will replace the culvert on 37th Street, southwest of Adams Street, as early as the beginning of October 2023 .* Construction is expected to be complete spring of 2024.

This bridge improvement project will include removing and replacing the existing bridge over the Boise City Canal.

*Construction schedules may change due to high demand for contractors, labor, and supplies.

Work substantially complete.

  • May 10, 2024

    Share May 10, 2024 on Facebook Share May 10, 2024 on Twitter Share May 10, 2024 on Linkedin Email May 10, 2024 link

    Work substantially complete.

  • April 25, 2024

    Share April 25, 2024 on Facebook Share April 25, 2024 on Twitter Share April 25, 2024 on Linkedin Email April 25, 2024 link
    • Asphalt paving was completed on April 18th.
    • Landscape repair work started.
    • Minor items remain.
  • April 19, 2024

    Share April 19, 2024 on Facebook Share April 19, 2024 on Twitter Share April 19, 2024 on Linkedin Email April 19, 2024 link
    • Sewer work for Garden City complete within project limits.
    • Road base prep is complete.
    • Asphalt paving was completed on April 18th.
  • April 12, 2024

    Share April 12, 2024 on Facebook Share April 12, 2024 on Twitter Share April 12, 2024 on Linkedin Email April 12, 2024 link
    • Sewer work for Garden City started April 1st.
    • Road base prep has started.
    • Contractor anticipates paving the week of April 15th.
  • April 5, 2024

    Share April 5, 2024 on Facebook Share April 5, 2024 on Twitter Share April 5, 2024 on Linkedin Email April 5, 2024 link
    • Sewer work for Garden City started April 1st.
    • Road base prep has started.
    • Contractor anticipates paving on the 15th of April.
  • March 29, 2024

    Share March 29, 2024 on Facebook Share March 29, 2024 on Twitter Share March 29, 2024 on Linkedin Email March 29, 2024 link
    • Sewer work for Garden City will start April 1st.
    • Road base prep has started.
  • March 21, 2024

    Share March 21, 2024 on Facebook Share March 21, 2024 on Twitter Share March 21, 2024 on Linkedin Email March 21, 2024 link
    • Sewer work for Garden City will start April 1st.
    • Grate and trash rack installed.
  • March 15, 2024

    Share March 15, 2024 on Facebook Share March 15, 2024 on Twitter Share March 15, 2024 on Linkedin Email March 15, 2024 link
    • Sewer work for Garden City will start in late March/early April.
    • Curb & gutter work complete.
    • Sidewalk placements on-going.
    • Grate and trash rack will be installed this week.
  • March 8, 2024

    Share March 8, 2024 on Facebook Share March 8, 2024 on Twitter Share March 8, 2024 on Linkedin Email March 8, 2024 link
    • Sewer work for Garden City will start in late March.
    • Curb & gutter work complete.
    • Sidewalk placements on-going.
    • Grate and trash rack in stall this week.
  • March 1, 2024

    Share March 1, 2024 on Facebook Share March 1, 2024 on Twitter Share March 1, 2024 on Linkedin Email March 1, 2024 link
    • Sewer work for Garden City will start the first week of March.
    • Curb & gutter work complete.
    • Sidewalk placements on-going.
