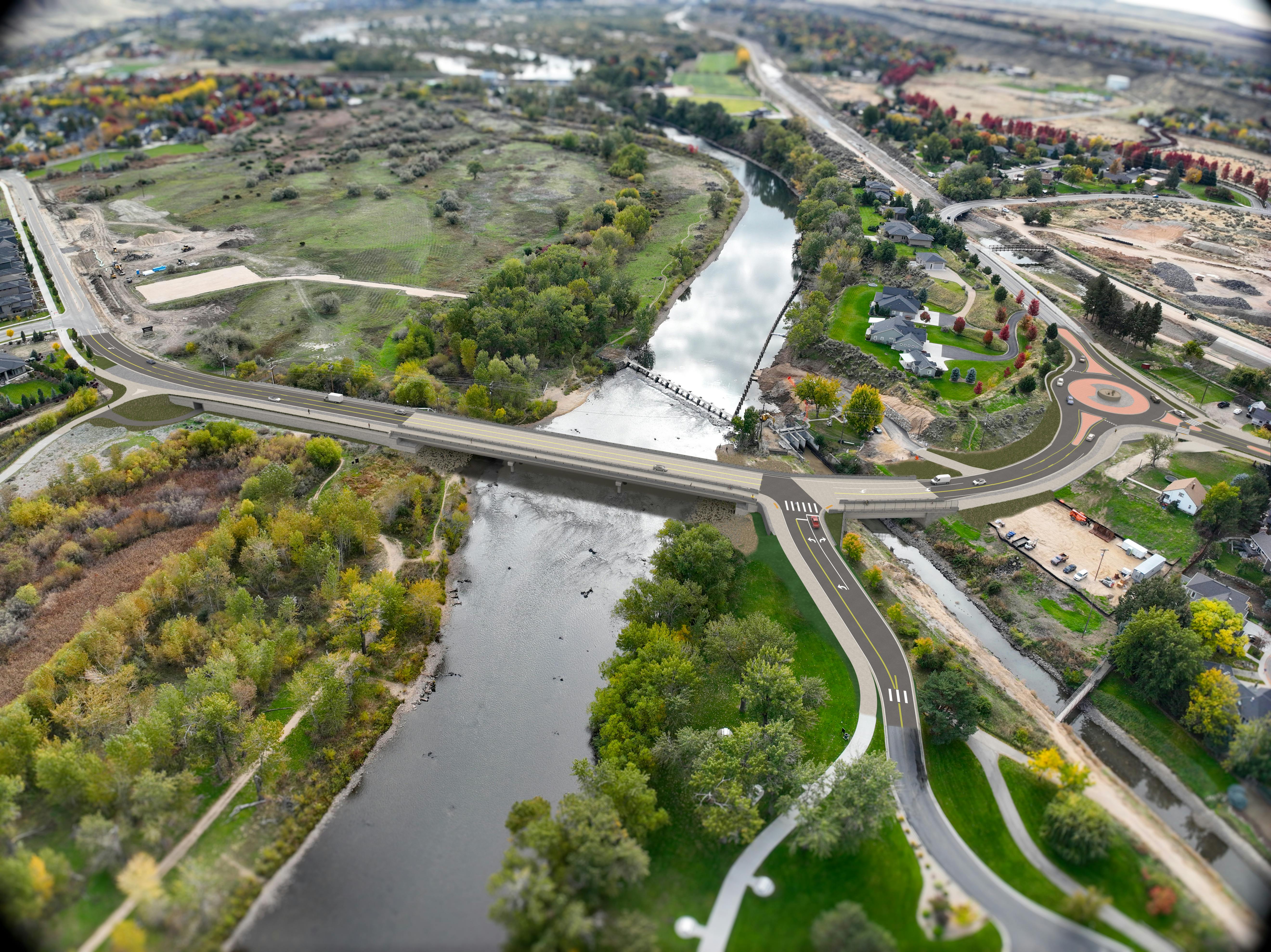

Eckert Road Bridge and Intersection Project

Share Eckert Road Bridge and Intersection Project on Facebook Share Eckert Road Bridge and Intersection Project on X (formerly Twitter) Share Eckert Road Bridge and Intersection Project on Linkedin Email Eckert Road Bridge and Intersection Project link

Eckert Road is an important corridor helping people get to nearby neighborhoods, Barber Park, the Greenbelt, and the Boise River. To make travel safer and easier, ACHD is planning several improvements in this area.

The project includes building a new Boise River Bridge that will serve everyone—drivers, walkers, and bikers—for many years. ACHD will also build a new bridge over the Ridenbaugh Canal and add a roundabout at the Boise Avenue and Eckert Road intersection.

The project is on an accelerated schedule due to the aging bridge structures and construction is anticipated to begin Fall 2026.

Project Highlights

  • Construct new bridges over the Boise River and Ridenbaugh Canal.
  • Add a multi-use pathway for pedestrians and bicyclists on the west side of Eckert Road between the Greenbelt and Boise Avenue.
  • Add a greenbelt tunnel under Eckert Road to connect the existing and future Greenbelt and the Dallas Harris Legacy Walkway.
  • Update the Barber Park driveway access.
  • Construct a single-lane roundabout at Boise Avenue and Eckert Road with Rectangular Rapid Flashing Beacons (RRFBs).

Project Coordination and Funding

ACHD has coordinated with local, state, and national agencies and conservation easement holders to avoid or mitigate impacts to wetlands, wildlife, and conservation easements.

ACHD is also partnering with the City of Boise. The City is funding the Greenbelt Underpass portion of the project, supporting safe and continuous access along the Boise River Greenbelt.

The Boise River Bridge portion is funded through state funds administered by the Local Highway Technical Assistance Council (LHTAC) via the Leading Idaho Local Bridge (LILB) Program.

Eckert Road is an important corridor helping people get to nearby neighborhoods, Barber Park, the Greenbelt, and the Boise River. To make travel safer and easier, ACHD is planning several improvements in this area.

The project includes building a new Boise River Bridge that will serve everyone—drivers, walkers, and bikers—for many years. ACHD will also build a new bridge over the Ridenbaugh Canal and add a roundabout at the Boise Avenue and Eckert Road intersection.

The project is on an accelerated schedule due to the aging bridge structures and construction is anticipated to begin Fall 2026.

Project Highlights

  • Construct new bridges over the Boise River and Ridenbaugh Canal.
  • Add a multi-use pathway for pedestrians and bicyclists on the west side of Eckert Road between the Greenbelt and Boise Avenue.
  • Add a greenbelt tunnel under Eckert Road to connect the existing and future Greenbelt and the Dallas Harris Legacy Walkway.
  • Update the Barber Park driveway access.
  • Construct a single-lane roundabout at Boise Avenue and Eckert Road with Rectangular Rapid Flashing Beacons (RRFBs).

Project Coordination and Funding

ACHD has coordinated with local, state, and national agencies and conservation easement holders to avoid or mitigate impacts to wetlands, wildlife, and conservation easements.

ACHD is also partnering with the City of Boise. The City is funding the Greenbelt Underpass portion of the project, supporting safe and continuous access along the Boise River Greenbelt.

The Boise River Bridge portion is funded through state funds administered by the Local Highway Technical Assistance Council (LHTAC) via the Leading Idaho Local Bridge (LILB) Program.

  • November 13, 2026

    Share November 13, 2026 on Facebook Share November 13, 2026 on X (formerly Twitter) Share November 13, 2026 on Linkedin Email November 13, 2026 link


    • Working on the permanent crossing.
    • Veolia is working on water across Boise River bridge.
    • Dewatering installation is ongoing.
    • Removal of bridge after dewatering setup.
    Intermountain Gas has completed the temporary relocation work. The company is continuing to monitor the temporary facilities to ensure service remains safe, reliable, and functioning as normal.

    Permanent relocation work by Intermountain Gas is on-going.


    • Working on the permanent crossing.
    • Veolia is working on water across Boise River bridge.
    • Dewatering installation is ongoing.
    • Removal of bridge after dewatering setup.
    Intermountain Gas has completed the temporary relocation work. The company is continuing to monitor the temporary facilities to ensure service remains safe, reliable, and functioning as normal.

    Permanent relocation work by Intermountain Gas is on-going.
  • November 6, 2026

    Share November 6, 2026 on Facebook Share November 6, 2026 on X (formerly Twitter) Share November 6, 2026 on Linkedin Email November 6, 2026 link
    • Intermountain Gas relocating gas line - Complete.
    • Working on the permanent crossing.
    • Veolia working on water across Boise River Bridge.
    • Dewatering installation is ongoing.
    • Trees have been removed.
    • Intermountain Gas relocating gas line - Complete.
    • Working on the permanent crossing.
    • Veolia working on water across Boise River Bridge.
    • Dewatering installation is ongoing.
    • Trees have been removed.
  • October 30, 2026

    Share October 30, 2026 on Facebook Share October 30, 2026 on X (formerly Twitter) Share October 30, 2026 on Linkedin Email October 30, 2026 link
    • Erosion control measures are being installed.
    • Intermountain Gas is relocating the gas line.
    • Veolia is working on water across the Boise River bridge.
    • Dewatering measures anticipated being installed pending approval from IDWR.
    • Trees are being removed.
    • Erosion control measures are being installed.
    • Intermountain Gas is relocating the gas line.
    • Veolia is working on water across the Boise River bridge.
    • Dewatering measures anticipated being installed pending approval from IDWR.
    • Trees are being removed.
  • October 22, 2026

    Share October 22, 2026 on Facebook Share October 22, 2026 on X (formerly Twitter) Share October 22, 2026 on Linkedin Email October 22, 2026 link
    • Erosion control measures being installed.
    • Intermountain Gas relocating gas line.
    • Veolia working on water across Boise River bridge.
    • Dewatering measures anticipated being installed starting Oct 23rd.
    • Erosion control measures being installed.
    • Intermountain Gas relocating gas line.
    • Veolia working on water across Boise River bridge.
    • Dewatering measures anticipated being installed starting Oct 23rd.
  • October 16, 2026

    Share October 16, 2026 on Facebook Share October 16, 2026 on X (formerly Twitter) Share October 16, 2026 on Linkedin Email October 16, 2026 link
    • Erosion control measures being installed October 12th.
    • Intermountain Gas is relocating gas line.
    • Erosion control measures being installed October 12th.
    • Intermountain Gas is relocating gas line.
  • Detours to start as early as October 12, 2026

    Share Detours to start as early as October 12, 2026 on Facebook Share Detours to start as early as October 12, 2026 on X (formerly Twitter) Share Detours to start as early as October 12, 2026 on Linkedin Email Detours to start as early as October 12, 2026 link

    Thank you to everyone that attended the construction open house! We were pleased that 183 neighbors took the time to come learn more about the upcoming construction work. If you missed the open house, the display boards, along with some key information from the open house can be found below.

    Key Information

    • Closures and detours will start as early as Monday, October 12th
    • Barber Park will remain open.
    • Parking at Barber Park will remain open.
    • The bridges will be closed and reconstructed first. When the bridges reopen, work on the Eckert Rd and Boise Ave intersection will start.

    Thank you to everyone that attended the construction open house! We were pleased that 183 neighbors took the time to come learn more about the upcoming construction work. If you missed the open house, the display boards, along with some key information from the open house can be found below.

    Key Information

    • Closures and detours will start as early as Monday, October 12th
    • Barber Park will remain open.
    • Parking at Barber Park will remain open.
    • The bridges will be closed and reconstructed first. When the bridges reopen, work on the Eckert Rd and Boise Ave intersection will start.

  • Construction to start in October

    Share Construction to start in October on Facebook Share Construction to start in October on X (formerly Twitter) Share Construction to start in October on Linkedin Email Construction to start in October link

    The Ada County Highway District (ACHD) will begin construction on the Eckert Road Bridge & Intersection Project at the beginning of October 2026*. Work is expected to be complete in Summer 2028.

    What to Expect

    • Closures and Detours: The road and bridges will be closed. Detours for motor vehicles, pedestrians, and bicyclists will follow the same routes previously used when the bridge was closed in the winter of 2025 for interim repairs.
    • Construction Noise: Equipment backup alarms, dust and ground vibration. Pile driving is expected to happen between 9 a.m. and 5 p.m.*
    • Weekday and Weekend Work: Weekday work will occur 7 a.m. to 7 p.m. and weekends 8 a.m. to 6 p.m. unless otherwise approved.
    • Access: Barber Park access will be maintained with a temporary bypass over the canal. The contractor will also work with property owners to minimize impacts and maintain access.
    • Traffic calming: A variety of tools will be used in nearby neighborhoods to manage traffic.

    * The process of hammering long structural columns, called piles, deep into the ground or riverbed to create a strong, stable deep foundation for the bridge.


    Join Us for a Construction Open House!

    • October 6, 2026 | 5-7 p.m.
    • Barber Park Education and Event Center | 4049 S Eckert Rd, Boise
    • Display boards


    The Ada County Highway District (ACHD) will begin construction on the Eckert Road Bridge & Intersection Project at the beginning of October 2026*. Work is expected to be complete in Summer 2028.

    What to Expect

    • Closures and Detours: The road and bridges will be closed. Detours for motor vehicles, pedestrians, and bicyclists will follow the same routes previously used when the bridge was closed in the winter of 2025 for interim repairs.
    • Construction Noise: Equipment backup alarms, dust and ground vibration. Pile driving is expected to happen between 9 a.m. and 5 p.m.*
    • Weekday and Weekend Work: Weekday work will occur 7 a.m. to 7 p.m. and weekends 8 a.m. to 6 p.m. unless otherwise approved.
    • Access: Barber Park access will be maintained with a temporary bypass over the canal. The contractor will also work with property owners to minimize impacts and maintain access.
    • Traffic calming: A variety of tools will be used in nearby neighborhoods to manage traffic.

    * The process of hammering long structural columns, called piles, deep into the ground or riverbed to create a strong, stable deep foundation for the bridge.


    Join Us for a Construction Open House!

    • October 6, 2026 | 5-7 p.m.
    • Barber Park Education and Event Center | 4049 S Eckert Rd, Boise
    • Display boards


  • Comment Summary

    Share Comment Summary on Facebook Share Comment Summary on X (formerly Twitter) Share Comment Summary on Linkedin Email Comment Summary link

    In December 2025 ACHD shared the bridge and intersection designs with the public, seeking the neighborhoods preferences on aesthetics. Residents could participate online and come to an open house that was held on December 9th.

    View the Comment Summary


    In December 2025 ACHD shared the bridge and intersection designs with the public, seeking the neighborhoods preferences on aesthetics. Residents could participate online and come to an open house that was held on December 9th.

    View the Comment Summary


  • View the bridge and intersection design

    Share View the bridge and intersection design on Facebook Share View the bridge and intersection design on X (formerly Twitter) Share View the bridge and intersection design on Linkedin Email View the bridge and intersection design link

    View the bridge and intersection designs, then take the survey to share your preferences about aesthetics. Let us know which bridge railing style you like best, as well as the textures you prefer for the railings and retaining wall areas.

    There are two ways to participate:

    View the bridge and intersection designs, then take the survey to share your preferences about aesthetics. Let us know which bridge railing style you like best, as well as the textures you prefer for the railings and retaining wall areas.

    There are two ways to participate:

  • Bridge Reopens

    Share Bridge Reopens on Facebook Share Bridge Reopens on X (formerly Twitter) Share Bridge Reopens on Linkedin Email Bridge Reopens link

    The Eckert Road Bridge is back open to vehicles, pedestrians and bicyclists after the completion of interim repairs. A final inspection by the Idaho Transportation Department confirmed that the bridge is safe for passenger vehicles and commercial traffic within legal load limits.

    The bridge was closed in January 2025 after an inspection identified significant structural decay. ACHD and ITD collaborated to complete the repairs quickly and safely, and reopened the bridge March 10.

    ACHD is actively working on plans for a full reconstruction of the bridge, with design work already underway. Construction is tentatively scheduled to begin in fall 2026. Updates on the replacement project will be provided as planning progresses.

    The Eckert Road Bridge is back open to vehicles, pedestrians and bicyclists after the completion of interim repairs. A final inspection by the Idaho Transportation Department confirmed that the bridge is safe for passenger vehicles and commercial traffic within legal load limits.

    The bridge was closed in January 2025 after an inspection identified significant structural decay. ACHD and ITD collaborated to complete the repairs quickly and safely, and reopened the bridge March 10.

    ACHD is actively working on plans for a full reconstruction of the bridge, with design work already underway. Construction is tentatively scheduled to begin in fall 2026. Updates on the replacement project will be provided as planning progresses.
