Resseguie | Fort | 15th St: Pavement Preservation & ADA Project

Share Resseguie | Fort | 15th St: Pavement Preservation & ADA Project on Facebook Share Resseguie | Fort | 15th St: Pavement Preservation & ADA Project on X (formerly Twitter) Share Resseguie | Fort | 15th St: Pavement Preservation & ADA Project on Linkedin Email Resseguie | Fort | 15th St: Pavement Preservation & ADA Project link

The Ada County Highway District (ACHD) will be reconstructing the following streets as part of the Pavement Preservation & ADA Project in Boise's North End. The work will start as early as mid-August 2025* and is expected to be complete in spring 2026.

  • Resseguie St., 9th to 16th streets,
  • Fort St., 16th St. to 15th St.
  • 15th St., Fort St. to Resseguie St.

Project Description

  • Rebuild Resseguie St and sections of Fort and 15th streets to replace the deteriorating pavement.
  • Replace select sections of curb where trees will not be impacted.
  • Install pedestrian ramps as needed to improve accessibility.
  • Retain historic curb stamps wherever feasible.

*Schedule subject to change.

The Ada County Highway District (ACHD) will be reconstructing the following streets as part of the Pavement Preservation & ADA Project in Boise's North End. The work will start as early as mid-August 2025* and is expected to be complete in spring 2026.

  • Resseguie St., 9th to 16th streets,
  • Fort St., 16th St. to 15th St.
  • 15th St., Fort St. to Resseguie St.

Project Description

  • Rebuild Resseguie St and sections of Fort and 15th streets to replace the deteriorating pavement.
  • Replace select sections of curb where trees will not be impacted.
  • Install pedestrian ramps as needed to improve accessibility.
  • Retain historic curb stamps wherever feasible.

*Schedule subject to change.

  • Updated Detour Map - July 30, 2026

    Share Updated Detour Map - July 30, 2026 on Facebook Share Updated Detour Map - July 30, 2026 on X (formerly Twitter) Share Updated Detour Map - July 30, 2026 on Linkedin Email Updated Detour Map - July 30, 2026 link

  • July 30, 2026

    Share July 30, 2026 on Facebook Share July 30, 2026 on X (formerly Twitter) Share July 30, 2026 on Linkedin Email July 30, 2026 link

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Resseguie, 13th Street and 16th Street is substantially complete. The intersection of Resseguie & 13th Street will be closed August 3rd – August 10th. Sidewalk and roadway improvements between 9th Street and 12th Street are on-going. Resseguie is closed during the work.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas’ work is complete between 9th and 10 th Streets. Intermountain Gas work is on-going between 10th and 12th Streets.

    Fort Street, 16th Street to 15th Street - Substantially completed on July 31st.

    15th Street, Fort Street to Resseguie Street - Substantially completed on July 31st.

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Resseguie, 13th Street and 16th Street is substantially complete. The intersection of Resseguie & 13th Street will be closed August 3rd – August 10th. Sidewalk and roadway improvements between 9th Street and 12th Street are on-going. Resseguie is closed during the work.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas’ work is complete between 9th and 10 th Streets. Intermountain Gas work is on-going between 10th and 12th Streets.

    Fort Street, 16th Street to 15th Street - Substantially completed on July 31st.

    15th Street, Fort Street to Resseguie Street - Substantially completed on July 31st.

  • July 23, 2026

    Share July 23, 2026 on Facebook Share July 23, 2026 on X (formerly Twitter) Share July 23, 2026 on Linkedin Email July 23, 2026 link

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Sidewalk and roadway improvements are on-going between 13th Street and 16th Street. Work is expected to be done by the end of July. Resseguie is closed during the work. Sidewalk and roadway improvements resumed July 9th between 9th Street and 11th Street. Resseguie is closed during the work.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas’ work is nearly complete between 9th and 11th Streets. Intermountain Gas work is on-going between 11th and 12th Streets.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Sidewalk and roadway improvements are on-going and are anticipated to be done by the end of July. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July. 15th Street is closed during the work.

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Sidewalk and roadway improvements are on-going between 13th Street and 16th Street. Work is expected to be done by the end of July. Resseguie is closed during the work. Sidewalk and roadway improvements resumed July 9th between 9th Street and 11th Street. Resseguie is closed during the work.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas’ work is nearly complete between 9th and 11th Streets. Intermountain Gas work is on-going between 11th and 12th Streets.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Sidewalk and roadway improvements are on-going and are anticipated to be done by the end of July. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July. 15th Street is closed during the work.

  • July 17, 2026

    Share July 17, 2026 on Facebook Share July 17, 2026 on X (formerly Twitter) Share July 17, 2026 on Linkedin Email July 17, 2026 link
    • Resseguie Street, 16th Street to 9th Street
      • PROJECT WORK:
        • Mainline pipe work is complete on Resseguie Street.
        • Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Work is expected to be done by the end of July. Resseguie is closed during the work.
        • Sidewalk and roadway improvements resumed July 9th between 9th Street and 11th Street. Resseguie is closed during the work.
      • UTILITY WORK:
        • Veolia’s work is complete.
        • Intermountain Gas’ work is complete between 13th and 16th Streets.
        • Intermountain Gas’ work is nearly complete between 9th and 11th Streets.
        • Intermountain Gas will relocate their line between 11th and 12th Street beginning July 9th.
    • Fort Street, 16th Street to 15th Street
      • PROJECT WORK:
        • Mainline pipe work is complete on Fort Street.
        • Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July.
        • Fort Street is closed during the work.
      • UTILITY WORK:
        • Veolia’s work is complete.
    • 15th Street, Fort Street to Resseguie Street
      • Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July.
      • 15th Street is closed during the work.
    • Resseguie Street, 16th Street to 9th Street
      • PROJECT WORK:
        • Mainline pipe work is complete on Resseguie Street.
        • Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Work is expected to be done by the end of July. Resseguie is closed during the work.
        • Sidewalk and roadway improvements resumed July 9th between 9th Street and 11th Street. Resseguie is closed during the work.
      • UTILITY WORK:
        • Veolia’s work is complete.
        • Intermountain Gas’ work is complete between 13th and 16th Streets.
        • Intermountain Gas’ work is nearly complete between 9th and 11th Streets.
        • Intermountain Gas will relocate their line between 11th and 12th Street beginning July 9th.
    • Fort Street, 16th Street to 15th Street
      • PROJECT WORK:
        • Mainline pipe work is complete on Fort Street.
        • Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July.
        • Fort Street is closed during the work.
      • UTILITY WORK:
        • Veolia’s work is complete.
    • 15th Street, Fort Street to Resseguie Street
      • Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July.
      • 15th Street is closed during the work.
  • July 9, 2026

    Share July 9, 2026 on Facebook Share July 9, 2026 on X (formerly Twitter) Share July 9, 2026 on Linkedin Email July 9, 2026 link

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Work is expected to be done by the end of July. Resseguie is closed during the work. Sidewalk and roadway improvements resumed July 9th between 9th Street and 11th Street. Resseguie is closed during the work.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas’ work is complete between 9th and 11th Streets. Intermountain Gas will relocate their line between 11th and 12th Street beginning July 9th.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete. 15th Street, Fort Street to Resseguie Street. Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July. 15th Street is closed during the work.

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Work is expected to be done by the end of July. Resseguie is closed during the work. Sidewalk and roadway improvements resumed July 9th between 9th Street and 11th Street. Resseguie is closed during the work.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas’ work is complete between 9th and 11th Streets. Intermountain Gas will relocate their line between 11th and 12th Street beginning July 9th.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete. 15th Street, Fort Street to Resseguie Street. Sidewalk and roadway improvements resumed June 1st and are anticipated to be done by the end of July. 15th Street is closed during the work.

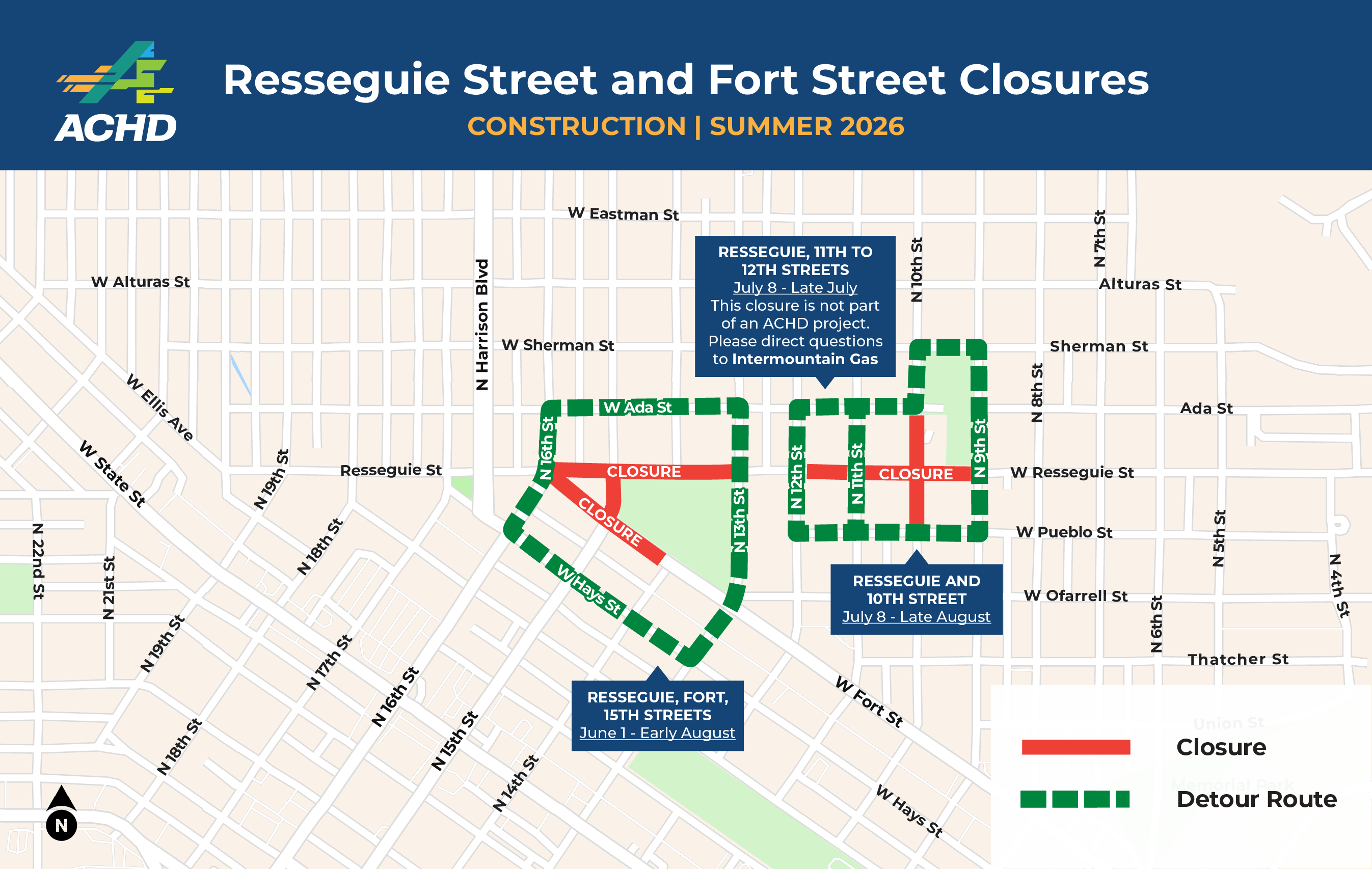

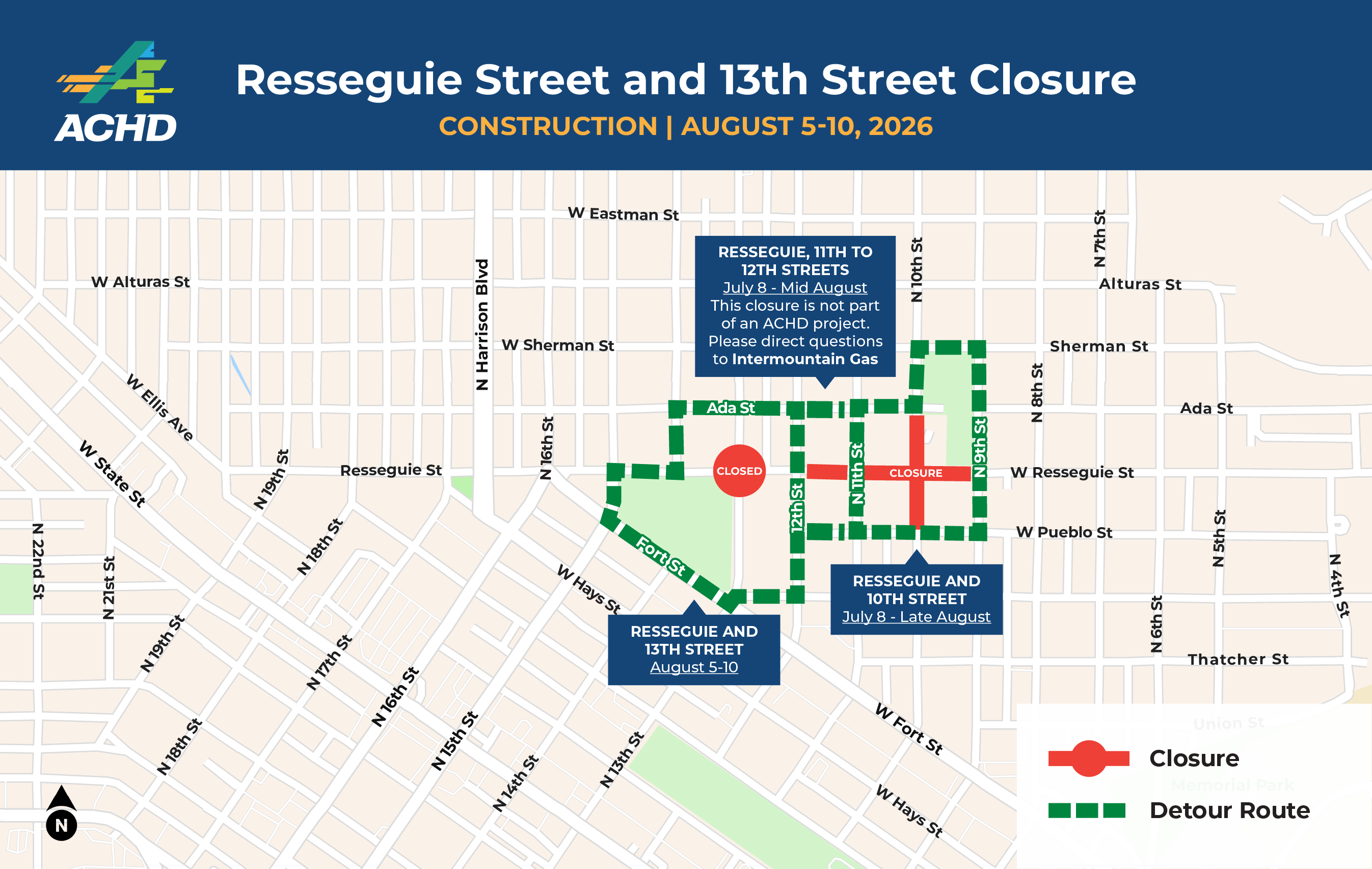

  • July 8, 2026 - Updated Detour Map and Information

    Share July 8, 2026 - Updated Detour Map and Information on Facebook Share July 8, 2026 - Updated Detour Map and Information on X (formerly Twitter) Share July 8, 2026 - Updated Detour Map and Information on Linkedin Email July 8, 2026 - Updated Detour Map and Information link

    Starting July 8th, Resseguie from 11th to 12th will be closed and is anticipated to re-open late July.

    Intermountain Gas is installing utility improvements in advance of ACHD's project.

    Please contact Intermountain Gas for questions.

    Starting July 8th, Resseguie from 11th to 12th will be closed and is anticipated to re-open late July.

    Intermountain Gas is installing utility improvements in advance of ACHD's project.

    Please contact Intermountain Gas for questions.

  • July 1, 2026

    Share July 1, 2026 on Facebook Share July 1, 2026 on X (formerly Twitter) Share July 1, 2026 on Linkedin Email July 1, 2026 link

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Resseguie will be closed between 13th Street and 16th Street during the work. 14th and 15th Streets will also be closed during the work. 13th and 16th Streets will remain open.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas will relocate the gas line between 9th Street and 11th Street beginning June 8 th. Resseguie is closed during their work. 10th Street is also be closed. 9th Street and 11th Street will remain open.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st o 15th Street is closed during the work.

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Resseguie will be closed between 13th Street and 16th Street during the work. 14th and 15th Streets will also be closed during the work. 13th and 16th Streets will remain open.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas will relocate the gas line between 9th Street and 11th Street beginning June 8 th. Resseguie is closed during their work. 10th Street is also be closed. 9th Street and 11th Street will remain open.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st o 15th Street is closed during the work.

  • June 26, 2026

    Share June 26, 2026 on Facebook Share June 26, 2026 on X (formerly Twitter) Share June 26, 2026 on Linkedin Email June 26, 2026 link

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Resseguie will be closed between 13th Street and 16th Street during the work. 14th and 15th Streets will also be closed during the work. 13th and 16th Streets will remain open.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas will relocate the gas line between 9th Street and 11th Street beginning June 8th. Resseguie is closed during their work. 10th Street is also be closed. 9th Street and 11th Street will remain open.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st.15th Street is closed during the work.

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Resseguie will be closed between 13th Street and 16th Street during the work. 14th and 15th Streets will also be closed during the work. 13th and 16th Streets will remain open.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas will relocate the gas line between 9th Street and 11th Street beginning June 8th. Resseguie is closed during their work. 10th Street is also be closed. 9th Street and 11th Street will remain open.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st.15th Street is closed during the work.

  • June 18, 2026

    Share June 18, 2026 on Facebook Share June 18, 2026 on X (formerly Twitter) Share June 18, 2026 on Linkedin Email June 18, 2026 link

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Resseguie will be closed between 13th Street and 16th Street during the work. 14th and 15th Streets will also be closed during the work. 13th and 16th Streets will remain open.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas will relocate the gas line between 9th Street and 11th Street beginning June 8th. Resseguie is closed during their work. 10th Street is also be closed. 9th Street and 11th Street will remain open.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st. 15th Street is closed during the work.

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Resseguie will be closed between 13th Street and 16th Street during the work. 14th and 15th Streets will also be closed during the work. 13th and 16th Streets will remain open.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas will relocate the gas line between 9th Street and 11th Street beginning June 8th. Resseguie is closed during their work. 10th Street is also be closed. 9th Street and 11th Street will remain open.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st. 15th Street is closed during the work.

  • June 12, 2026

    Share June 12, 2026 on Facebook Share June 12, 2026 on X (formerly Twitter) Share June 12, 2026 on Linkedin Email June 12, 2026 link

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Resseguie will be closed between 13th Street and 16th Street during the work. 14th and 15th Streets will also be closed during the work. 13th and 16th Streets will remain open.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas will relocate the gas line between 9th Street and 11th Street beginning June 8th. Resseguie is closed during their work. 10th Street is also be closed. 9th Street and 11th Street will remain open.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st. 15th Street is closed during the work.

    Resseguie Street, 16th Street to 9th Street

    PROJECT WORK: Mainline pipe work is complete on Resseguie Street. Sidewalk and roadway improvements resumed June 1st between 13th Street and 16th Street. Resseguie will be closed between 13th Street and 16th Street during the work. 14th and 15th Streets will also be closed during the work. 13th and 16th Streets will remain open.

    UTILITY WORK: Veolia’s work is complete. Intermountain Gas’ work is complete between 13th and 16th Streets. Intermountain Gas will relocate the gas line between 9th Street and 11th Street beginning June 8th. Resseguie is closed during their work. 10th Street is also be closed. 9th Street and 11th Street will remain open.

    Fort Street, 16th Street to 15th Street

    PROJECT WORK: Mainline pipe work is complete on Fort Street. Sidewalk and roadway improvements resumed June 1st. Fort Street is closed during the work.

    UTILITY WORK: Veolia’s work is complete.

    15th Street, Fort Street to Resseguie Street - Sidewalk and roadway improvements resumed June 1st. 15th Street is closed during the work.

Page last updated: 30 Jul 2026, 04:14 PM
