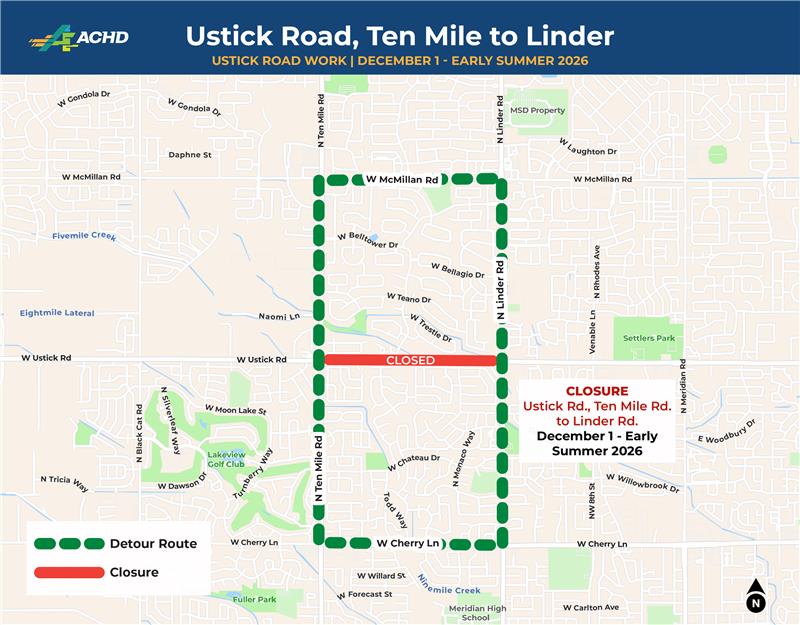

Ustick Road, Ten Mile Road to Linder Road
The Ada County Highway District (ACHD) is widening Ustick Road, Ten Mile Road to Linder Road. The purpose of this project is to improve traffic flow and increase safety for all users. Work is expected to be complete in late 2026.*
Project Description
- Widen Ustick Road, Ten Mile to Linder, to two travel lanes in each direction with a continuous center turn lane.
- Raised medians will be located within the center lane in areas where they do not restrict access from public streets and/or driveways.
- Construct a 10-foot, multi-use pathway on the north and south sides of Ustick Road.
- Install a traffic signal at the intersection of Ustick Road and Towerbridge Way.
- Construct a new pedestrian bridge crossing over Five Mile Creek to provide a connection with the multi-use pathway.
- The multi-use pathway will transition to bike lanes and attached sidewalks at the Ustick Road and Ten Mile Road intersection.
Traffic and Construction Impacts
- Road closures are expected during construction
- Lane restrictions with flaggers
- General construction noise, dust, equipment backup alarms and ground vibration
- Crews will work from 7 a.m. to 7 p.m. unless otherwise approved
- The contractor will work with property owners to minimize impacts and maintain access
*Construction schedules may change
The Ada County Highway District (ACHD) is widening Ustick Road, Ten Mile Road to Linder Road. The purpose of this project is to improve traffic flow and increase safety for all users. Work is expected to be complete in late 2026.*
Project Description
- Widen Ustick Road, Ten Mile to Linder, to two travel lanes in each direction with a continuous center turn lane.
- Raised medians will be located within the center lane in areas where they do not restrict access from public streets and/or driveways.
- Construct a 10-foot, multi-use pathway on the north and south sides of Ustick Road.
- Install a traffic signal at the intersection of Ustick Road and Towerbridge Way.
- Construct a new pedestrian bridge crossing over Five Mile Creek to provide a connection with the multi-use pathway.
- The multi-use pathway will transition to bike lanes and attached sidewalks at the Ustick Road and Ten Mile Road intersection.
Traffic and Construction Impacts
- Road closures are expected during construction
- Lane restrictions with flaggers
- General construction noise, dust, equipment backup alarms and ground vibration
- Crews will work from 7 a.m. to 7 p.m. unless otherwise approved
- The contractor will work with property owners to minimize impacts and maintain access
*Construction schedules may change
-
February 19, 2026
Share February 19, 2026 on Facebook Share February 19, 2026 on Twitter Share February 19, 2026 on Linkedin Email February 19, 2026 link- Ustick Road closure started December 1st.
- Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal is complete for a portion of Ustick.
- Contractor has completed setting the bypass pipe down Five Mile Creek.
- Contactor continues excavating/backfilling from the east for the retaining wall along Five Mile Creek.
- Contractor continues setting baskets for the bottom lift(s) of the retaining wall.
- Work on the City of Meridian sewer install and bypass at Glennfield Way and Ustick continues.
- Clearing and grubbing work is ongoing.
- Utility relocations are ongoing.
-
February 12, 2026
Share February 12, 2026 on Facebook Share February 12, 2026 on Twitter Share February 12, 2026 on Linkedin Email February 12, 2026 link- Ustick Road closure started December 1st.
- Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal is complete for a portion of Ustick.
- Contractor has completed setting the bypass pipe down Five Mile Creek.
- Contactor continues excavating/backfilling from the east for the retaining wall along Five Mile Creek.
- Contractor continues setting baskets for the bottom lift(s) of the retaining wall.
- Work on the City of Meridian sewer install and bypass at Glennfield Way and Ustick continues.
- Clearing and grubbing work is ongoing.
- Utility relocations are ongoing.
-
February 5, 2026
Share February 5, 2026 on Facebook Share February 5, 2026 on Twitter Share February 5, 2026 on Linkedin Email February 5, 2026 link- Ustick Road closure started December 1st.
- Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal is complete for a portion of Ustick.
- Contractor has completed setting the bypass pipe down Five Mile Creek.
- Contactor continues excavating/backfilling from the east for the retaining wall along Five Mile Creek.
- Contractor has started setting baskets for the bottom lift(s) of the retaining wall.
- City of Meridian sewer bypass and CIPP lining installation is complete.
- Work on the City of Meridian sewer install and bypass at Glennfield Way and Ustick continues.
- Clearing and grubbing work is ongoing.
- Utility relocations are ongoing.
-
January 30, 2026
Share January 30, 2026 on Facebook Share January 30, 2026 on Twitter Share January 30, 2026 on Linkedin Email January 30, 2026 link- Ustick Road closure started December 1st.
- Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal is complete for a portion of Ustick.
- Contractor has completed setting the bypass pipe down Five Mile Creek.
- Contactor has started excavating/backfilling from the east for the retaining wall along Five Mile Creek.
- City of Meridian sewer bypass and CIPP lining installation is complete.
- Work on the City of Meridian sewer install and bypass at Glennfield Way and Ustick continues.
- Clearing and grubbing work is ongoing.
- Utility relocations are ongoing.
-
January 23, 2026
Share January 23, 2026 on Facebook Share January 23, 2026 on Twitter Share January 23, 2026 on Linkedin Email January 23, 2026 link- Ustick Road closure started December 1st o Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal is complete for a portion of Ustick.
- Contractor has completed setting the bypass pipe down Five Mile Creek.
- Contactor has started excavating from the east for the retaining wall along Five Mile Creek.
- City of Meridian sewer bypass and CIPP lining installation is complete.
- Work on the City of Meridian sewer install and bypass at Glennfield Way and Ustick started this week.
- Clearing and grubbing work is ongoing.
- Utility relocations ongoing.
-
January 16, 2026
Share January 16, 2026 on Facebook Share January 16, 2026 on Twitter Share January 16, 2026 on Linkedin Email January 16, 2026 link- Ustick Road closure started December 1st.
- Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal is complete for a portion of Ustick.
- Contractor is continuing to set the bypass pipe down Five Mile Creek.
- Contactor has started excavating from the east for the retaining wall along Five Mile Creek.
- City of Meridian sewer bypass and CIPP lining installation is complete.
- Contractor is staging and setting up for City of Meridian sewer install and bypass at Glennfield Way and Ustick.
- Clearing and grubbing work is ongoing.
-
January 9, 2026
Share January 9, 2026 on Facebook Share January 9, 2026 on Twitter Share January 9, 2026 on Linkedin Email January 9, 2026 link- Ustick Road closure started December 1st.
- Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal is complete for a portion of Ustick.
- Contractor is continuing to set the bypass pipe down Five Mile Creek.
- Contactor has started excavating from the east for the retaining wall along Five Mile Creek.
- City of Meridian sewer bypass and CIPP lining installation is complete.
- Contractor is staging and setting up for City of Meridian sewer install and bypass at Glennfield Way and Ustick.
- Clearing and grubbing work is ongoing.
-
December 18, 2025
Share December 18, 2025 on Facebook Share December 18, 2025 on Twitter Share December 18, 2025 on Linkedin Email December 18, 2025 link- Ustick Road closure started December 1st.
- Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal is complete for a portion of Ustick.
- Contractor is staging and preparing for the dewatering operation of Five Mile Creek.
- City of Meridian sewer bypass and CIPP lining installation started this week.
- Clearing and grubbing work is ongoing.
-
December 11, 2025
Share December 11, 2025 on Facebook Share December 11, 2025 on Twitter Share December 11, 2025 on Linkedin Email December 11, 2025 link- Ustick Road closure started December 1st.
- Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal is complete for a portion of Ustick.
- Contractor is staging and preparing for the dewatering operation of Five Mile Creek.
- Contractor is staging and preparing for the City of Meridian sewer bypass – expected to start Dec 15.
- Clearing and grubbing work is ongoing.
-
December 4, 2025
Share December 4, 2025 on Facebook Share December 4, 2025 on Twitter Share December 4, 2025 on Linkedin Email December 4, 2025 link- Ustick Road closure started December 1st o Message boards, traffic calming throughout the adjacent neighborhoods, etc. have been installed.
- Roadway milling/removal has started on Ustick.
- Contractor is staging and preparing for the dewatering operation of Five Mile Creek.
- Contractor is staging a preparing for the City of Meridian sewer bypass.
Follow Project
Drone Footage
Contact Us
Who's Listening
-
Project Manager
Phone 208-387-6100 Email connect@achdidaho.org -
Construction Coordinator
Phone 208-387-6100 Email connect@achdidaho.org -
Community and Business Relations Coordinator
Phone 208-387-6100 Email connect@achdidaho.org
Timeline
-
Winter 2020
Ustick Road, Ten Mile Road to Linder Road has finished this stageAsked the community about their experience using this section of Ustick Road
-
2021
Ustick Road, Ten Mile Road to Linder Road has finished this stageUsing public feedback, ACHD started the design
-
Fall 2022
Ustick Road, Ten Mile Road to Linder Road has finished this stageGathered feedback on the current design
-
2025
Ustick Road, Ten Mile Road to Linder Road has finished this stageBegan purchasing property necessary for the project
-
Late October 2025
Ustick Road, Ten Mile Road to Linder Road is currently at this stageStart construction
-
Late 2026
this is an upcoming stage for Ustick Road, Ten Mile Road to Linder RoadConstruction is expected to be complete.*
Documents
-
Fall 2022 Public Outreach
-
Ustick_ Ten Mile to Linder Comments Infographic (689 KB) (pdf)
-
Ustick_ Ten Mile to Linder_ Public Involvement Summary (2.85 MB) (pdf)
-
Project Information (Ustick Ten Mile to Linder Rd)
-
Ustick, Ten Mile Rd to Linder Rd - Full Overview Displays.pdf (3.05 MB) (pdf)
-
Ustick, Ten Mile Rd to Linder Rd - Center Turn Lane Displays.pdf (991 KB) (pdf)
-
Ustick, Ten Mile Rd to Linder Rd - Multi-use Pathway Display.pdf (823 KB) (pdf)
-
Ustick, Ten Mile Rd to Linder Rd - Traffic Signal.pdf (1.22 MB) (pdf)
-
Ustick, Ten Mile Rd to Linder Rd - Pedestrian Bridge Crossing.pdf (1.08 MB) (pdf)
-
Ustick, Ten Mile Rd to Linder Rd - Raised Median Displays.pdf (991 KB) (pdf)
-
Ustick, Ten Mile Rd to Linder Rd - Bike Lanes and Attached Sidewalks.pdf (1.13 MB) (pdf)
-
Ustick, Ten Mile Rd to Linder Rd - Design Set.pdf (6.47 MB) (pdf)
-
Ustick, Ten Mile Rd to Linder Rd - Typical Section Displays.pdf (991 KB) (pdf)
-
-
Winter 2020 Public Outreach
