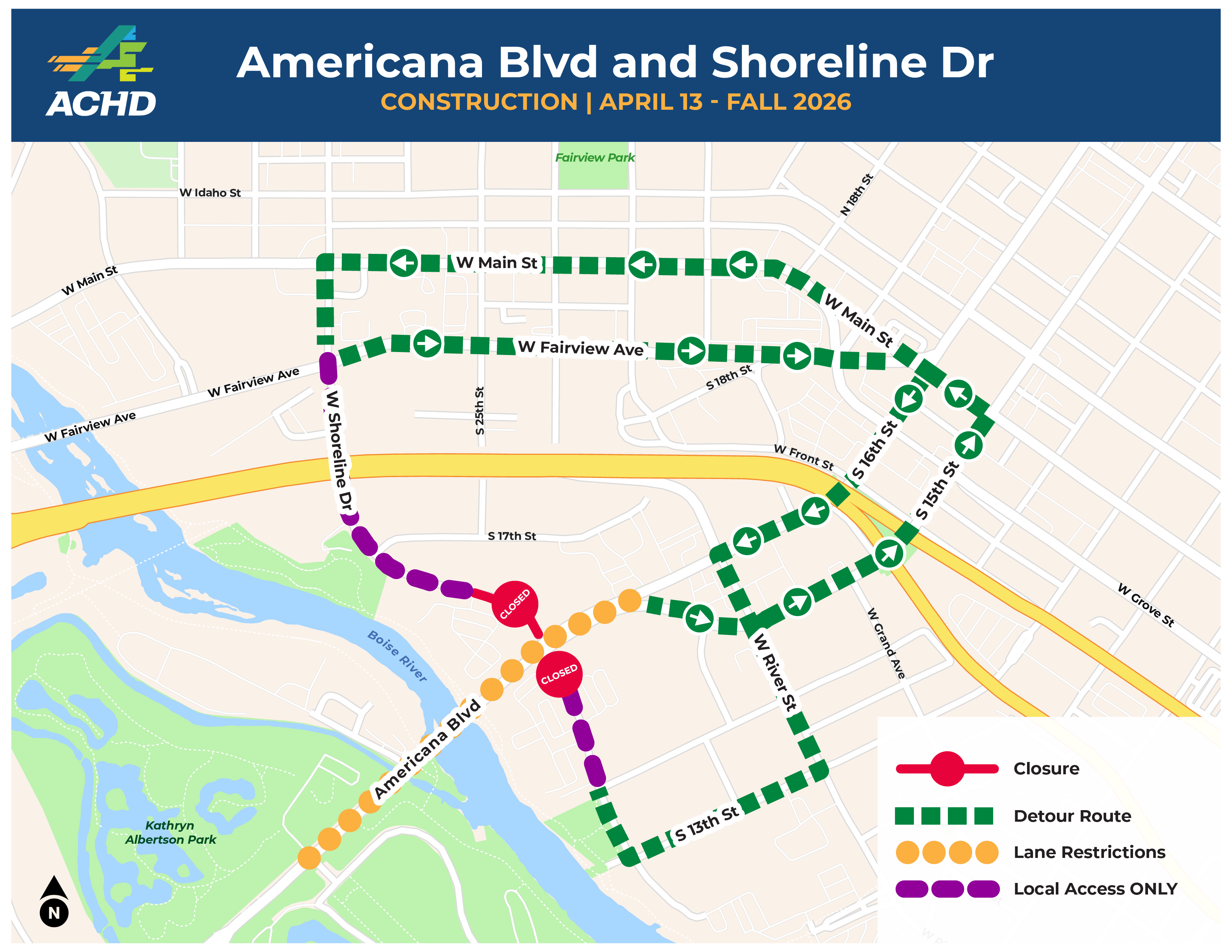

Americana Boulevard | Shoreline Drive | Eisenman Road
The Ada County Highway District (ACHD) will be rehabilitating several streets in your area as part of a federally funded project to improve pavement conditions and upgrade the streets for all users.
As part of the street reconstruction, ACHD will upgrade select pedestrian ramps and driveways to meet current Americans with Disabilities Act (ADA) standards. The work also includes improvements for people walking and biking, such as improved crossings and bike lane enhancements. These changes are intended to improve safety and accessibility for everyone using the street.
Project Descriptions
Eisenman Road
Eisenman Road, Gowen Road to 2000 feet south of Gowen Road
Removing and replacing pavement
Upgrading pedestrian ramps and driveways for current ADA compliance
The existing Gowen Road intersection signal will not be impacted
Eisenman Road, Freight Street to East Bound I-84 Offramp
Removing and replacing pavement
Americana Boulevard
Americana Boulevard, Ann Morrison Park Boulevard to Shoreline Drive
Removing and replacing pavement
Upgrading pedestrian ramps and driveways for current ADA compliance
Traffic signals at Ann Morrison Park Boulevard and Shoreline Drive will be updated for current Accessible Pedestrian Signal (APS) compliance
Maintaining the existing roadway configuration of two lanes in each direction with a center turn lane and bike lanes
Constructing protected intersection treatment at Shoreline Drive intersection to enhance pedestrian and bicyclist accessibility and safety at the crossings
Constructing drainage improvements within the existing right-of-way to treat stormwater
Shoreline Drive
Shoreline Drive, Americana Boulevard to Fairview Avenue
Removing and replacing pavement
Upgrading pedestrian ramps and driveways for current ADA compliance
Improving existing bike lanes with raised buffer medians
Installing a Rectangular Rapid Flashing Beacon (RRFB) at the entrance to the firefighter memorial entrance
The existing traffic signal at Fairview Avenue will not be impacted
The Ada County Highway District (ACHD) will be rehabilitating several streets in your area as part of a federally funded project to improve pavement conditions and upgrade the streets for all users.
As part of the street reconstruction, ACHD will upgrade select pedestrian ramps and driveways to meet current Americans with Disabilities Act (ADA) standards. The work also includes improvements for people walking and biking, such as improved crossings and bike lane enhancements. These changes are intended to improve safety and accessibility for everyone using the street.
Project Descriptions
Eisenman Road
Eisenman Road, Gowen Road to 2000 feet south of Gowen Road
Removing and replacing pavement
Upgrading pedestrian ramps and driveways for current ADA compliance
The existing Gowen Road intersection signal will not be impacted
Eisenman Road, Freight Street to East Bound I-84 Offramp
Removing and replacing pavement
Americana Boulevard
Americana Boulevard, Ann Morrison Park Boulevard to Shoreline Drive
Removing and replacing pavement
Upgrading pedestrian ramps and driveways for current ADA compliance
Traffic signals at Ann Morrison Park Boulevard and Shoreline Drive will be updated for current Accessible Pedestrian Signal (APS) compliance
Maintaining the existing roadway configuration of two lanes in each direction with a center turn lane and bike lanes
Constructing protected intersection treatment at Shoreline Drive intersection to enhance pedestrian and bicyclist accessibility and safety at the crossings
Constructing drainage improvements within the existing right-of-way to treat stormwater
Shoreline Drive
Shoreline Drive, Americana Boulevard to Fairview Avenue
Removing and replacing pavement
Upgrading pedestrian ramps and driveways for current ADA compliance
Improving existing bike lanes with raised buffer medians
Installing a Rectangular Rapid Flashing Beacon (RRFB) at the entrance to the firefighter memorial entrance
The existing traffic signal at Fairview Avenue will not be impacted
-
September 11, 2026 - Eisenman
Share September 11, 2026 - Eisenman on Facebook Share September 11, 2026 - Eisenman on X (formerly Twitter) Share September 11, 2026 - Eisenman on Linkedin Email September 11, 2026 - Eisenman linkEisenman Rd, Gowen Rd to 2000’ South
- Milling and paving is complete.
- Veolia’s work to replace the water line is complete.
Eisenman Rd, Freight St to I-84
- Work is started August 24th.
- Eisenman Road will remain open for the work.
- Milling and paving on the segment from Freight Street to the truck stop is complete.
- Mill and paving from the truck stop to I-84 was completed September 11th.c
- Minor work remains, including manhole adjustments and striping.
Eisenman Rd, Gowen Rd to 2000’ South
- Milling and paving is complete.
- Veolia’s work to replace the water line is complete.
Eisenman Rd, Freight St to I-84
- Work is started August 24th.
- Eisenman Road will remain open for the work.
- Milling and paving on the segment from Freight Street to the truck stop is complete.
- Mill and paving from the truck stop to I-84 was completed September 11th.c
- Minor work remains, including manhole adjustments and striping.
-
September 11, 2026 - Americana
Share September 11, 2026 - Americana on Facebook Share September 11, 2026 - Americana on X (formerly Twitter) Share September 11, 2026 - Americana on Linkedin Email September 11, 2026 - Americana link- Shoreline Dr, Americana Blvd to Fairview Ave
- Signal work at Americana & Shoreline began August 24th and will take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping are complete.
- The west leg of Shoreline will remain open to right-in and right-out only traffic and will remain in this configuration until the new traffic signal is complete.
- The east leg of Shoreline was closed August 24th for the signal work.
- Shoreline Dr, Americana Blvd to Fairview Ave
- Signal work at Americana & Shoreline began August 24th and will take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping are complete.
- The west leg of Shoreline will remain open to right-in and right-out only traffic and will remain in this configuration until the new traffic signal is complete.
- The east leg of Shoreline was closed August 24th for the signal work.
- Shoreline Dr, Americana Blvd to Fairview Ave
-
September 3, 2026 - Eisenman
Share September 3, 2026 - Eisenman on Facebook Share September 3, 2026 - Eisenman on X (formerly Twitter) Share September 3, 2026 - Eisenman on Linkedin Email September 3, 2026 - Eisenman link- Eisenman Rd, Gowen Rd to 2000’ South - Milling and paving is complete. Minor work remains – striping, manhole adjustments, concrete sidewalk, etc. Veolia’s work to replace the water line is complete.
- Eisenman Rd, Freight St to I-84 - Work is started August 24th. Eisenman Road will remain open for the work. Milling and paving on the segment from Freight Street to the truck stop is complete. Mill and paving from the truck stop to I-84 will continue on September 9th. Work impacting I-84 will be done at night.
- Eisenman Rd, Gowen Rd to 2000’ South - Milling and paving is complete. Minor work remains – striping, manhole adjustments, concrete sidewalk, etc. Veolia’s work to replace the water line is complete.
- Eisenman Rd, Freight St to I-84 - Work is started August 24th. Eisenman Road will remain open for the work. Milling and paving on the segment from Freight Street to the truck stop is complete. Mill and paving from the truck stop to I-84 will continue on September 9th. Work impacting I-84 will be done at night.
-
September 3, 2026
Share September 3, 2026 on Facebook Share September 3, 2026 on X (formerly Twitter) Share September 3, 2026 on Linkedin Email September 3, 2026 link- Signal work at Americana & Shoreline began August 24th and will take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping are complete.
- The west leg of Shoreline will remain open to right-in and right-out only traffic and will remain in this configuration until the new traffic signal is complete.
- The east leg of Shoreline was closed August 24th for the signal work.
- Signal work at Americana & Shoreline began August 24th and will take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping are complete.
- The west leg of Shoreline will remain open to right-in and right-out only traffic and will remain in this configuration until the new traffic signal is complete.
- The east leg of Shoreline was closed August 24th for the signal work.
-
August 28, 2026
Share August 28, 2026 on Facebook Share August 28, 2026 on X (formerly Twitter) Share August 28, 2026 on Linkedin Email August 28, 2026 link- Shoreline Dr, Americana Blvd to Fairview Ave
- Signal work at Americana & Shoreline began August 24th and will take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping are complete.
- The west leg of Shoreline will remain open to right-in and right-out only traffic and will remain in this configuration until the new traffic signal is complete.
- The east leg of Shoreline was closed August 24th for the signal work.
- Eisenman Rd, Gowen Rd to 2000’ South
- Milling and paving is complete.
- Minor work remains – striping, manhole adjustments, concrete sidewalk, etc.
- Veolia’s work to replace the water line is complete.
- Eisenman Rd, Freight St to I-84
- Work is started August 24th. Eisenman Road will remain open for the work.
- Milling and paving on the segment from Freight Street to the truck stop is complete.
- Mill and paving from the truck stop to I-84 will continue in early September. Work impacting I-84 will be done at night.
- Shoreline Dr, Americana Blvd to Fairview Ave
- Signal work at Americana & Shoreline began August 24th and will take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping are complete.
- The west leg of Shoreline will remain open to right-in and right-out only traffic and will remain in this configuration until the new traffic signal is complete.
- The east leg of Shoreline was closed August 24th for the signal work.
- Eisenman Rd, Gowen Rd to 2000’ South
- Milling and paving is complete.
- Minor work remains – striping, manhole adjustments, concrete sidewalk, etc.
- Veolia’s work to replace the water line is complete.
- Eisenman Rd, Freight St to I-84
- Work is started August 24th. Eisenman Road will remain open for the work.
- Milling and paving on the segment from Freight Street to the truck stop is complete.
- Mill and paving from the truck stop to I-84 will continue in early September. Work impacting I-84 will be done at night.
- Shoreline Dr, Americana Blvd to Fairview Ave
-
August 20, 2026
Share August 20, 2026 on Facebook Share August 20, 2026 on X (formerly Twitter) Share August 20, 2026 on Linkedin Email August 20, 2026 linkShoreline Dr, Americana Blvd to Fairview Ave
- Signal work at Americana & Shoreline is anticipated to begin August 24th and take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete.
- The west leg of Shoreline will remain open to right-in and right-out only traffic and will remain in this configuration until the new traffic signal is complete.
- The east leg of Shoreline will be closed beginning August 24th for the signal work.
Eisenman Rd, Gowen Rd to 2000’ South
- ACHD’s project started August 5th.
- Eisenman Rd will remain open for the ACHD project.
- Milling and paving on the east side are complete.
- Milling and paving on the west side is anticipated to be complete on August 21st.
- After paving is complete, minor work remains – striping, manhole adjustments, etc.
- Veolia’s work to replace the water line is complete.
Eisenman Rd, Freight St to I-84 - Work is scheduled to start as early as August 24th. Eisenman Road will remain open for the work.
Shoreline Dr, Americana Blvd to Fairview Ave
- Signal work at Americana & Shoreline is anticipated to begin August 24th and take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete.
- The west leg of Shoreline will remain open to right-in and right-out only traffic and will remain in this configuration until the new traffic signal is complete.
- The east leg of Shoreline will be closed beginning August 24th for the signal work.
Eisenman Rd, Gowen Rd to 2000’ South
- ACHD’s project started August 5th.
- Eisenman Rd will remain open for the ACHD project.
- Milling and paving on the east side are complete.
- Milling and paving on the west side is anticipated to be complete on August 21st.
- After paving is complete, minor work remains – striping, manhole adjustments, etc.
- Veolia’s work to replace the water line is complete.
Eisenman Rd, Freight St to I-84 - Work is scheduled to start as early as August 24th. Eisenman Road will remain open for the work.
-
August 14, 2026
Share August 14, 2026 on Facebook Share August 14, 2026 on X (formerly Twitter) Share August 14, 2026 on Linkedin Email August 14, 2026 linkShoreline Dr, Americana Blvd to Fairview Ave
- Signal work at Americana & Shoreline is anticipated to begin August 24th and take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete.
- Shoreline was re-opened for right-in and right-out only traffic on August 4th and will remain in this configuration until the new traffic signal is complete.
Eisenman Rd, Gowen Rd to 2000’ South
- ACHD’s project started August 5th.
- Eisenman Rd will remain open for the ACHD project.
- Milling started August 7th.
- Asphalt paving started August 11th.
- Veolia’s work to replace the water line is complete.
Eisenman Rd, Freight St to I-84
- Work is scheduled to start in late August or early September. Eisenman Road will be closed for this portion of the ACHD project.
Shoreline Dr, Americana Blvd to Fairview Ave
- Signal work at Americana & Shoreline is anticipated to begin August 24th and take 3-4 weeks to complete.
- Signal work at Americana & Ann Morrison Park/Kathryn Albertson Park is expected to resume in November after remaining signal materials are delivered.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete.
- Shoreline was re-opened for right-in and right-out only traffic on August 4th and will remain in this configuration until the new traffic signal is complete.
Eisenman Rd, Gowen Rd to 2000’ South
- ACHD’s project started August 5th.
- Eisenman Rd will remain open for the ACHD project.
- Milling started August 7th.
- Asphalt paving started August 11th.
- Veolia’s work to replace the water line is complete.
Eisenman Rd, Freight St to I-84
- Work is scheduled to start in late August or early September. Eisenman Road will be closed for this portion of the ACHD project.
-
August 7, 2026
Share August 7, 2026 on Facebook Share August 7, 2026 on X (formerly Twitter) Share August 7, 2026 on Linkedin Email August 7, 2026 linkProject includes work on the following segments:
- Americana Blvd, Ann Morrison Park Blvd to Shoreline Dr
- Shoreline Dr, Americana Blvd to Fairview Ave
- Electrical work for new traffic signals is on-going. Waiting for signal materials to be delivered later this year.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete
- Shoreline was re-opened for right-in and right-out only traffic on August 4th and will remain in this configuration until the new traffic signal is complete.
- Eisenman Rd, Gowen Rd to 2000’ South
- ACHD’s project started August 5th. Eisenman Rd will remain open for the ACHD project.
- Veolia’s work to replace the water line is complete.
- Eisenman Rd, Freight St to I-84
- Work is scheduled to start in late August or early September. Eisenman Road will be closed for this portion of the ACHD project.
Project includes work on the following segments:
- Americana Blvd, Ann Morrison Park Blvd to Shoreline Dr
- Shoreline Dr, Americana Blvd to Fairview Ave
- Electrical work for new traffic signals is on-going. Waiting for signal materials to be delivered later this year.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete
- Shoreline was re-opened for right-in and right-out only traffic on August 4th and will remain in this configuration until the new traffic signal is complete.
- Eisenman Rd, Gowen Rd to 2000’ South
- ACHD’s project started August 5th. Eisenman Rd will remain open for the ACHD project.
- Veolia’s work to replace the water line is complete.
- Eisenman Rd, Freight St to I-84
- Work is scheduled to start in late August or early September. Eisenman Road will be closed for this portion of the ACHD project.
- Americana Blvd, Ann Morrison Park Blvd to Shoreline Dr
-
July 30, 2026
Share July 30, 2026 on Facebook Share July 30, 2026 on X (formerly Twitter) Share July 30, 2026 on Linkedin Email July 30, 2026 linkShoreline Dr, Americana Blvd to Fairview Ave
- Electrical work for new traffic signals is on-going.
- Waiting for signal materials to be delivered later this year.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete.
- Shoreline will be re-opened for right-in and right-out only traffic on August 4th and remain in this configuration until the new traffic signal is complete.
Eisenman Rd, Gowen Rd to 2000’ South
- ACHD’s project is anticipated to start August 5th.
- Eisenman Road will remain open for the ACHD project.
- Veolia is replacing the water line in advance of the project.
- Eisenman Road is closed for their work, anticipated to re-open on August 4th.
Shoreline Dr, Americana Blvd to Fairview Ave
- Electrical work for new traffic signals is on-going.
- Waiting for signal materials to be delivered later this year.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete.
- Shoreline will be re-opened for right-in and right-out only traffic on August 4th and remain in this configuration until the new traffic signal is complete.
Eisenman Rd, Gowen Rd to 2000’ South
- ACHD’s project is anticipated to start August 5th.
- Eisenman Road will remain open for the ACHD project.
- Veolia is replacing the water line in advance of the project.
- Eisenman Road is closed for their work, anticipated to re-open on August 4th.
-
July 23, 2026
Share July 23, 2026 on Facebook Share July 23, 2026 on X (formerly Twitter) Share July 23, 2026 on Linkedin Email July 23, 2026 linkShoreline Dr, Americana Blvd to Fairview Ave
- Electrical work for new traffic signals is on-going.
- Waiting for signal materials to be delivered later this year.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete.
- Shoreline will be re-opened for right-in and right-out only traffic until the new traffic signal is complete.
Shoreline Dr, Americana Blvd to Fairview Ave
- Electrical work for new traffic signals is on-going.
- Waiting for signal materials to be delivered later this year.
- Concrete sidewalk improvements are complete until signal materials arrive.
- Milling, paving, and striping is complete.
- Shoreline will be re-opened for right-in and right-out only traffic until the new traffic signal is complete.
-
Sr. Project Manager
Phone 208-387-6100 Email connect@achdidaho.org -
Community and Business Relations Coordinator
Phone 208-387-6100 Email connect@achdidaho.org
-
Fall 2023
Americana Boulevard | Shoreline Drive | Eisenman Road has finished this stageDesign Started
-
Winter 2024
Americana Boulevard | Shoreline Drive | Eisenman Road has finished this stageSeek Public Feedback
-
Summer 2025
Americana Boulevard | Shoreline Drive | Eisenman Road has finished this stageFinalize Design
-
2026
Americana Boulevard | Shoreline Drive | Eisenman Road is currently at this stageStart Construction
-
Winter 2024 Public Outreach
-
Project Information.pdf (27.6 MB) (pdf)
-
Infographic Summary (2024 Pavement and Pedestrian Improvements) (180 KB) (pdf)
-
Public Comment Summary (2024 Pavement and Pedestrian Improvements) (5.42 MB) (pdf)
-
Americana Blvd - Ann Morrison Park Blvd to Shoreline Dr (836 KB) (pdf)
-
Shoreline Dr - Americana Blvd to Fairview Ave (782 KB) (pdf)
-
Gowen Rd to Rockrose Way (5.16 MB) (pdf)
-
Grand Forest Dr and Quamash Way Intersection (1.95 MB) (pdf)
-
Lake Forest Dr - Federal Way to Summersweet Dr (805 KB) (pdf)
-
Lake Forest Dr and Quamash Way Intersection (1.73 MB) (pdf)
-
Eisenman Rd - Gowen Road to south of Gowen Road (594 KB) (pdf)
-
Eisenman Rd - Freight Street to eastbound I-84 Offramp (1.75 MB) (pdf)
-
