Downtown Eagle Mobility Improvements: Eagle Road and State Street

Share Downtown Eagle Mobility Improvements: Eagle Road and State Street on Facebook Share Downtown Eagle Mobility Improvements: Eagle Road and State Street on Twitter Share Downtown Eagle Mobility Improvements: Eagle Road and State Street on Linkedin Email Downtown Eagle Mobility Improvements: Eagle Road and State Street link

The Eagle Road and State Street intersection is the gateway to the City of Eagle and an important part of the downtown core. As a gateway, it serves vehicles, bicyclists and pedestrians of all ages who want to access local businesses, neighborhoods, the elementary school, and the senior center.

The Ada County Highway District (ACHD), working with the City of Eagle, is currently designing improvements to Eagle Road and State Street and the connecting roadway network which includes Olde Park Place, Plaza Drive and Aikens Street.

Goals

The goal of the street network improvements is to improve safety and mobility for all users while accommodating future traffic growth and creating a welcoming downtown environment.

The Eagle Road and State Street intersection is the gateway to the City of Eagle and an important part of the downtown core. As a gateway, it serves vehicles, bicyclists and pedestrians of all ages who want to access local businesses, neighborhoods, the elementary school, and the senior center.

The Ada County Highway District (ACHD), working with the City of Eagle, is currently designing improvements to Eagle Road and State Street and the connecting roadway network which includes Olde Park Place, Plaza Drive and Aikens Street.

Goals

The goal of the street network improvements is to improve safety and mobility for all users while accommodating future traffic growth and creating a welcoming downtown environment.

  • May 30, 2025

    30 May 2025
    Share May 30, 2025 on Facebook Share May 30, 2025 on Twitter Share May 30, 2025 on Linkedin Email May 30, 2025 link

    Olde Park

    • Landscape ongoing.
    • Brick paver installation.

    Aikens between 2nd and Eagle

    • Placing silva cells.
    • Placing ¾” aggregate for road base.
    • Electrical work ongoing.
    • Curb and sidewalk ongoing.
    • Asphalt paving was done May 29th. Road to be opened June 6th after striping and manhole collaring is complete.

    Olde Park To Eagle Rd

    • Road closure anticipated May 5th – June 6th
    • Veolia installing water – Night work starting May 14th.
    • Silva cells ongoing.
    • Prepping and placing sidewalk crossings.
    • Paving scheduled for May 30th.

    Starting June 6th, Eagle Road will be closed between Plaza and Old State. Veolia is installing a water line. Excavation and storm drain installation.


  • New Construction Phasing

    22 May 2025
    Share New Construction Phasing on Facebook Share New Construction Phasing on Twitter Share New Construction Phasing on Linkedin Email New Construction Phasing link

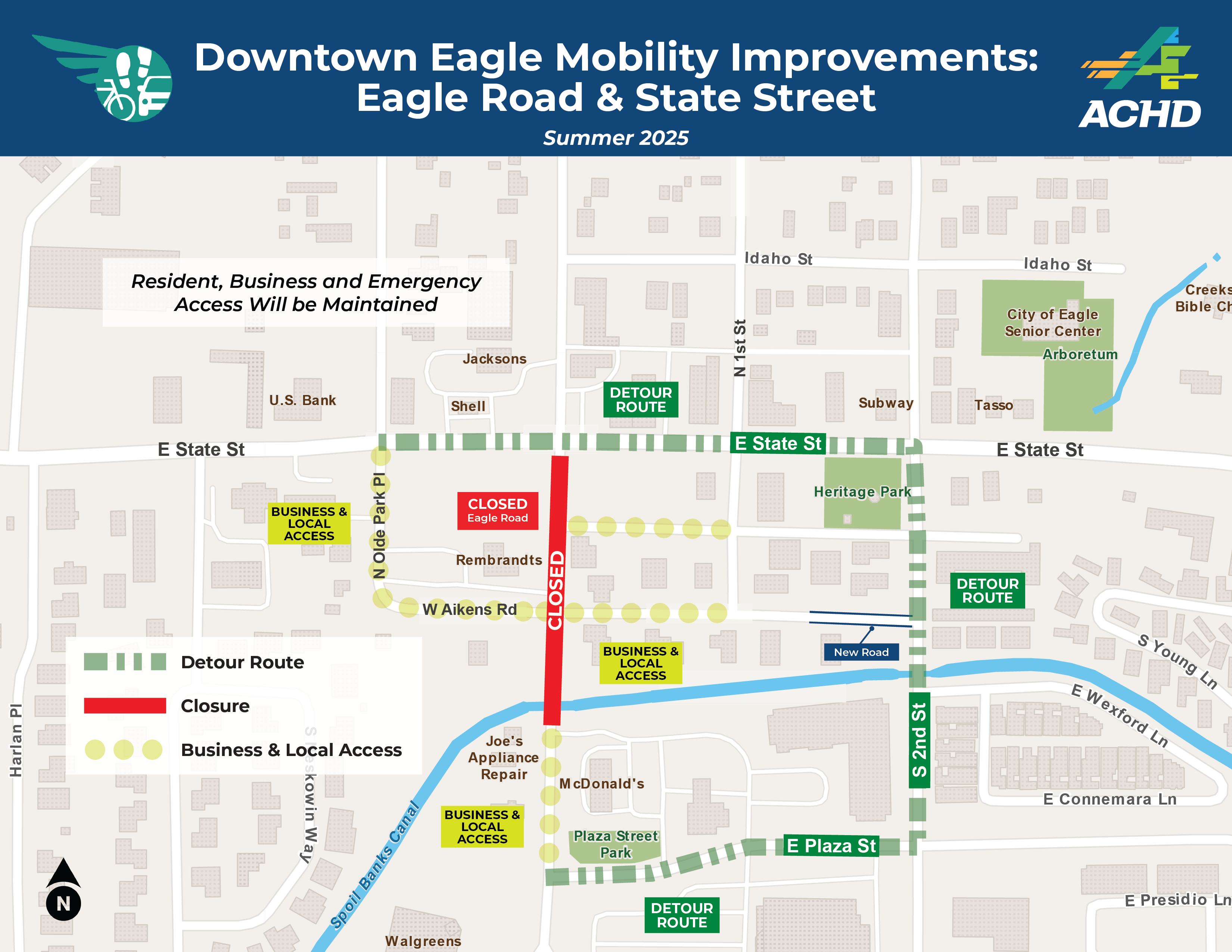

    supporting image

  • May 22, 2025 - Construction Update

    22 May 2025
    Share May 22, 2025 - Construction Update on Facebook Share May 22, 2025 - Construction Update on Twitter Share May 22, 2025 - Construction Update on Linkedin Email May 22, 2025 - Construction Update link

    Olde Park

    • Landscape ongoing
    • Brick paver installation

    Aikens between 2nd and Eagle

    • Placing silva cells
    • Placing ¾” aggregate for road base
    • Electrical work ongoing
    • Curb and sidewalk ongoing
    • Paving anticipated the week of May 26th

    Olde Park To Eagle Rd

    • Road closure anticipated May 5th – May 30th
    • Veolia installing water – Night work starting May 14th
    • Silva cells ongoing
    • Prepping and placing sidewalk crossings
    • Paving anticipated the week of May 26t

    Eagle Rd Closure - Starting approximately June 4th - Veolia placing utilities. Sidewalk work.

  • May 22, 2025 - New Closure Information

    22 May 2025
    Share May 22, 2025 - New Closure Information on Facebook Share May 22, 2025 - New Closure Information on Twitter Share May 22, 2025 - New Closure Information on Linkedin Email May 22, 2025 - New Closure Information link

    Beginning June 2nd, Eagle Road will be closed in downtown Eagle between State Street and Plaza Drive.

    To get around the closure, commuters should use Plaza Street and 2nd Street as a detour.


    Local residential and business access will be maintained throughout the duration of the closure, including Cedar Ridge Street and Aikens Street. Aikens Street now extends east to 2nd Street.

    This phase of construction is expected to be completed by June 26th. ACHD has coordinated this roadwork to wrap up before the beginning of Eagle Fun Days. The work is part of ACHD's Downtown Eagle Mobility Improvements Project, which is expected to be complete by the end of 2025.



  • May 16, 2025

    16 May 2025
    Share May 16, 2025 on Facebook Share May 16, 2025 on Twitter Share May 16, 2025 on Linkedin Email May 16, 2025 link

    Olde Park Place

    • Landscape ongoing
    • Brick pavers being installed.

    Aikens between 2nd and Eagle

    • Placing silva cells
    • Placing ¾” aggregate for road base.
    • Electrical work ongoing.
    • Curb and sidewalk ongoing.

    Olde Park To Eagle Rd

    • Road closure anticipated May 5th – May 30th.
    • Veolia installing water – Night work starting May 14th.
    • Silva cells ongoing.
    • Prepping and placing sidewalk crossings.


  • May 8, 2025

    08 May 2025
    Share May 8, 2025 on Facebook Share May 8, 2025 on Twitter Share May 8, 2025 on Linkedin Email May 8, 2025 link

    Olde Park Place

    • Landscape ongoing.
    • Brick pavers installation.

    Aikens between 2nd and Eagle

    • Placing silva cells.
    • Placing ¾” aggregate for road base.
    • Electrical work ongoing.
    • Curb anticipated week of May 5th.

    Olde Park to Eagle Rd

    • Road closure anticipated May 5th – end of May.
    • Veolia installing water.
    • Silva cells ongoing.
    • Prepping and placing sidewalk crossings.
  • May 1, 2025

    01 May 2025
    Share May 1, 2025 on Facebook Share May 1, 2025 on Twitter Share May 1, 2025 on Linkedin Email May 1, 2025 link

    Olde Park

    • Landscape ongoing

    Aikens between 2nd and Eagle

    • Placing Silva Cells
    • Placing ¾” aggregate for road base
    • Electrical work ongoing
    • Curb anticipated week of May 5th

    Olde Park To Eagle Rd

    • Road closure anticipated May 5th – May 30th
    • Veolia installing water
    • Silva cells ongoing
    • Prepping and placing sidewalk crossings
  • May 1, 2025 - New Detour Map & Information

    01 May 2025
    Share May 1, 2025 - New Detour Map & Information on Facebook Share May 1, 2025 - New Detour Map & Information on Twitter Share May 1, 2025 - New Detour Map & Information on Linkedin Email May 1, 2025 - New Detour Map & Information link

    State (Old State) between Olde Park Place and Eagle Road will be closed from

    May 5th through the end of May.

  • April 25, 2025

    25 Apr 2025
    Share April 25, 2025 on Facebook Share April 25, 2025 on Twitter Share April 25, 2025 on Linkedin Email April 25, 2025 link

    Veolia

    • Working at the intersection of Olde Park and State Street
    • Lane shifts to install crossings
    • Started Aikens and 2nd on March 31st - Complete.

    Olde Park

    • Paving complete.
    • Concrete collars and pavement markings ongoing.
    • Landscape ongoing.

    Aikens between 2nd and Eagle

    • Placing Silva Cells.
    • Placing ¾” aggregate for road base.
    • Storm drain and irrigation complete.
    • Electrical work ongoing.

    Olde Park To Eagle Rd on State (Old State)

    • Road closure anticipated second week of May through end of May.


  • April 17, 2025

    17 Apr 2025
    Share April 17, 2025 on Facebook Share April 17, 2025 on Twitter Share April 17, 2025 on Linkedin Email April 17, 2025 link

    Veolia

    • Working at the intersection of Olde Park and State Street.
    • Lane shifts to install crossings.
    • Starting Aikens and 2nd on March 31st - Complete.

    Olde Park

    • Silva Cells ongoing.
    • Electrical and landscaping ongoing.
    • Working in State Street on Silva Cells.
    • Curb and gutter ongoing.
    • Paving anticipated the week of April 21st.
    • Pavement markings after paving.

    Aikens between 2nd and Eagle

    • Sub grading road.
    • Placing Silva Cells.
    • Storm drain and irrigation ongoing.
    • Electrical work ongoing.
